Multi-Building Campus Roofing Strategy: How to Plan $2M+ Across 8-15 Buildings Smart

| By TriVAN Roofing | 14 min read

Multi-Building Campus Roofing Strategy: How to Plan $2M+ Across 8-15 Buildings Smart

School districts and hospitals face complex decisions allocating limited capital across multiple buildings. Learn strategic frameworks for prioritizing $2M+ roofing investments across 8-15 buildings over 5-7 years.

Categories: Commercial Roofing

You're staring at a spreadsheet showing twelve buildings, roof ages ranging from 8 to 24 years, and a total replacement cost estimate of $2.8 million. Your annual capital budget? $400,000. The challenge facing school districts, hospitals, and corporate campuses across Texas and Oklahoma isn't unique, but the solution requires strategic thinking that goes far beyond "replace the oldest roof first."

Managing roofing investments across multiple buildings demands a systematic approach that balances condition, criticality, risk, and budget reality. The difference between reactive patch-and-pray management and strategic capital planning often determines whether your organization thrives or struggles with emergency repairs and budget overruns.

The Assessment Phase: Building Your Foundation

The foundation of any successful multi-building roofing strategy starts with comprehensive roof condition assessment across your entire portfolio. This isn't about walking around with a clipboard noting obvious problems. Professional assessment requires systematic evaluation methodology that creates defensible data for capital planning decisions.

A proper assessment includes remaining useful life estimates for each building based on membrane type, installation quality, maintenance history, and current condition. For a typical school district with twelve buildings, this process takes 2-3 days and costs $3,000-5,000 but saves tens of thousands in poor prioritization decisions.

The assessment should document specific condition indicators: membrane degradation levels, seam integrity, drain functionality, insulation condition, and any interior damage evidence. Each building receives standardized condition ratings that allow objective comparison across your portfolio. Without this foundation, you're making million-dollar decisions based on incomplete information.

Cost estimation for each building must account for complexity factors beyond simple square footage. A 20,000 square foot elementary school with multiple roof levels, numerous penetrations, and occupied-building constraints costs significantly more per square foot than a simple warehouse of identical size. The assessment should provide realistic replacement costs that account for these variables.

Prioritization Factors: Beyond Just Age

The most effective campus roofing strategies use a priority matrix that weighs both building criticality and roof condition. Age alone creates poor prioritization. A 15-year-old roof in excellent condition on a storage building shouldn't receive priority over a 12-year-old roof with active leaks on your main academic building.

Building criticality encompasses multiple factors. An elementary school serving 600 students obviously outranks a rarely-used maintenance building, but the analysis goes deeper. Consider occupancy density, facility replacement cost, operational disruption potential, and revenue impact. A hospital emergency department operates differently than a medical office building, even if both roofs show similar aging.

Interior damage risk varies dramatically between buildings. A library housing expensive computer equipment and irreplaceable materials faces higher consequences from roof leaks than a warehouse storing bulk supplies. This risk assessment should factor into prioritization even when roof conditions appear similar.

Occupancy during replacement affects both cost and scheduling flexibility. Schools that can vacate buildings during summer break offer easier access and lower project costs than facilities requiring occupied-building protocols. Hospitals face the extreme version of this challenge, where some areas never close and others allow weekend or overnight work.

Historical leak frequency provides crucial insight beyond current condition assessment. A building with recurring leak problems despite recent repairs suggests underlying issues that make replacement more urgent than condition alone might indicate. Conversely, a building with excellent maintenance history might justify delaying replacement despite showing age-related wear.

The Risk Assessment Factor

Consider two buildings with identical 16-year-old roofs showing similar wear patterns. Building A houses mechanical equipment on the roof, creating high consequences if leaks damage HVAC systems worth $200,000. Building B serves as basic storage with minimal equipment at risk. Despite similar roof conditions, Building A deserves priority based on potential consequential damage.

This risk-based thinking applies across facility types. A data center with servers requires different prioritization than a cafeteria. A surgical suite demands different consideration than a waiting room. The priority matrix must account for both probability of failure and magnitude of consequences.

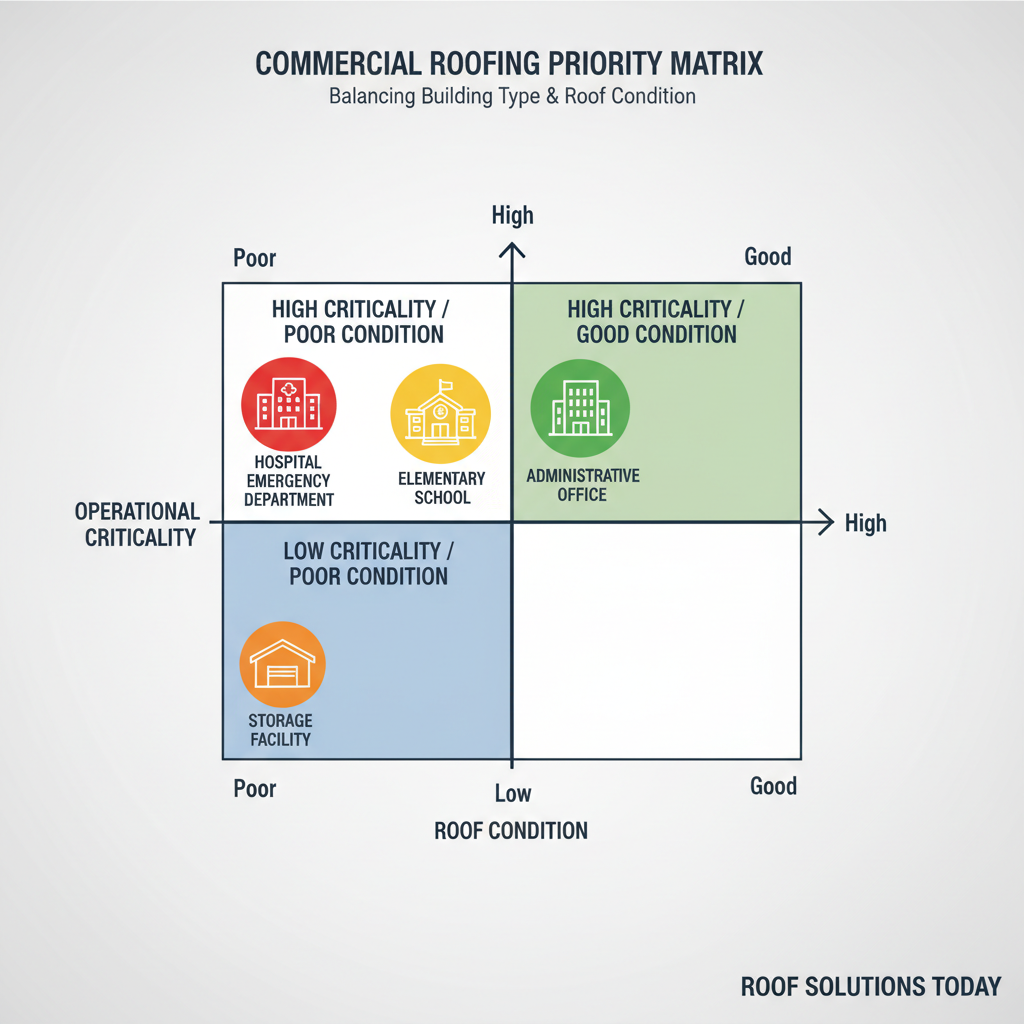

Building priority matrix showing criticality versus roof condition for strategic planning
This priority matrix demonstrates how building criticality and roof condition combine to create clear replacement priorities. High-criticality buildings with poor roof conditions (upper left quadrant) demand immediate attention, while low-criticality buildings with good roofs (lower right) can wait. The framework prevents the common mistake of replacing roofs based solely on age rather than strategic importance to operations.

Three Strategic Approaches to Multi-Building Planning

Organizations typically choose between three strategic frameworks for multi-building roofing replacement, each with distinct advantages depending on budget constraints and risk tolerance.

Worst-First Strategy

The worst-first approach prioritizes buildings with the most deteriorated roofs regardless of building importance. This strategy makes sense when roof failures pose immediate risks and emergency replacement costs significantly exceed planned replacement costs. However, it can result in replacing roofs on low-priority buildings while critical facilities continue operating with marginally acceptable roofs.

This strategy works best for organizations with adequate budget flexibility and buildings where roof failure consequences don't vary dramatically. A corporate campus with similar office buildings might successfully use worst-first prioritization, while a school district with diverse building types needs more nuanced approaches.

Critical-First Strategy

Critical-first strategy protects the most important buildings first regardless of current roof condition. This approach ensures your highest-priority operations receive new roofs before problems develop, but may leave deteriorated roofs on less critical buildings to fail before replacement arrives.

Hospitals often favor this approach, prioritizing emergency departments and surgical suites even when their roofs show less wear than administrative buildings. The strategy accepts higher temporary repair costs on low-priority buildings to ensure critical operations never face roof-related disruptions.

Hybrid Strategy (Recommended)

The most successful multi-building strategies use hybrid approaches that balance condition and criticality. This framework typically prioritizes buildings that rank high in either condition urgency or operational criticality, while avoiding the extremes of either pure strategy.

A practical hybrid matrix might prioritize any building ranking in the top 25% for criticality or bottom 25% for roof condition. This ensures both emergency situations and critical operations receive appropriate attention while maintaining strategic flexibility for budget allocation.

Seven-year phased roofing replacement timeline showing annual building priorities and budgets
Phased replacement scheduling allows organizations to spread major capital investments across multiple budget years while maintaining logical priority sequences. This 7-year timeline shows how annual budgets of $350K-450K can address $2.8M in total roofing needs through strategic sequencing. The approach prevents budget shock while ensuring critical buildings receive priority attention based on condition and operational importance.

Phased Replacement Economics: Spreading the Load

Most successful multi-building strategies replace 2-3 buildings annually, spreading costs across multiple budget cycles. This approach offers several economic advantages beyond simple budget management.

Replacing multiple buildings per year allows organizations to maintain relationships with qualified contractors, often resulting in better pricing through volume commitments and repeat business. Contractors appreciate predictable work streams and often offer competitive pricing for multi-year commitments versus one-off projects.

The phased approach enables learning from early projects to improve later phases. Issues discovered during the first year's replacements, whether design improvements, contractor performance, or scheduling challenges, can be addressed in subsequent years. This continuous improvement process often results in better outcomes and lower costs as the program matures.

Organizations avoid the overwhelming complexity of managing multiple simultaneous large projects. Replacing two buildings annually allows proper project oversight and quality control, while attempting to replace six buildings simultaneously often results in management problems and quality issues.

Real-World Example: Hospital System Strategy

Consider a hospital system with eight buildings, $2.2 million total replacement need, and $350,000 annual budget capacity. The priority assessment revealed:

  • Emergency department building: Most critical operations, roof condition good (7 years remaining life)
  • Surgery center: High criticality, roof condition marginal (2 years remaining)
  • Medical office building: Lower criticality, roof actively failing (immediate need)
  • Administrative building: Medium criticality, roof condition fair (4 years remaining)
  • Patient tower: High criticality, roof condition good (5 years remaining)

The strategic sequence prioritizes immediate needs while protecting critical operations:

  • Year 1: Medical office building (failing roof, $280,000)
  • Year 2: Surgery center (critical function, marginal roof, $320,000)
  • Year 3: Administrative building (condition declining, $240,000)
  • Year 4: Patient tower (proactive replacement, $380,000)
  • Year 5: Emergency department (proactive replacement, $400,000)
  • Years 6-7: Remaining support buildings ($580,000 total)

This sequence balances immediate needs, protects critical functions, and maintains budget predictability while avoiding emergency replacement premiums.

Summer Scheduling: The School District Challenge

School districts face unique scheduling constraints that significantly impact multi-building roofing strategies. Every district wants roofing work completed during the June-August window when buildings are vacant, creating massive demand spikes that strain contractor capacity and inflate pricing.

Summer scheduling challenges often add 15-25% to project costs due to contractor capacity constraints and overtime requirements. Districts planning multiple building replacements must develop strategies that balance scheduling convenience with budget reality.

Consider shoulder season work for buildings that can accommodate disruption. April-May and September-October often provide better contractor availability and pricing for buildings where temporary relocation is possible. Administrative buildings, gymnasiums, and some specialized facilities can often accommodate off-peak scheduling.

Winter work becomes viable for genuinely unoccupied buildings or those where interior protection allows continued occupancy. Storage buildings, maintenance facilities, and some administrative areas can be re-roofed during winter months at significant cost savings.

Staggered summer scheduling across multiple years prevents competing with yourself for contractor capacity. Rather than attempting four building replacements in one summer, plan two buildings each summer across two years. This approach often reduces total project costs while improving contractor quality and attention.

Creative Scheduling Solutions

Progressive school districts develop creative scheduling that maximizes summer availability for high-disruption projects while using alternative timing for buildings where occupancy can be managed. A typical strategy might include:

  • Summer: Elementary schools and buildings requiring complete interior protection
  • Spring break: Administrative buildings and offices with temporary relocation options
  • Fall/winter: Gymnasiums, storage buildings, and facilities with flexible occupancy
  • Weekend/holiday work: Buildings where short-duration access allows progress without major disruption

TIPS Purchasing: Multi-Year Contract Advantages

TIPS cooperative purchasing contracts provide significant advantages for multi-building roofing strategies, particularly in the competitive Texas and Oklahoma markets where TriVAN maintains active contracts.

The ability to award contracts for multiple buildings over multiple years eliminates annual re-bidding requirements, saving $20,000-30,000 in procurement costs per building. These savings alone often justify the strategic planning investment required for multi-year approaches.

Pre-negotiated pricing provides budget predictability that enables confident long-term planning. Rather than hoping next year's bid climate remains favorable, organizations can lock in pricing for entire multi-year programs. This certainty allows better capital planning and often reveals opportunities to accelerate replacement schedules when pricing proves favorable.

Job Order Contract (JOC) structures within TIPS contracts allow task-order approaches where pricing is pre-established for various building types and complexity factors. This eliminates the delay and expense of individual project bidding while maintaining competitive pricing through the original TIPS selection process.

The cooperative purchasing power often results in better pricing than individual district solicitations, particularly for smaller organizations that lack significant negotiating leverage. TIPS contracts aggregate demand across multiple organizations, creating economies of scale that benefit all participants.

Temporary Repairs vs. Replacement Timing

Multi-year planning inevitably creates situations where buildings need attention before their scheduled replacement year. The decision between temporary repairs and accelerated replacement requires careful economic analysis that considers both immediate costs and long-term strategy.

Temporary repair versus replacement timing decisions often determine the success of multi-building strategies. A building with 3-5 years remaining useful life but replacement not budgeted for four years faces a common dilemma: spend $8,000-15,000 in temporary repairs to bridge the gap versus accelerate the replacement schedule.

The analysis must consider repair effectiveness and longevity. Minor seam repairs or drain adjustments that reliably extend roof life 3-4 years often represent smart investments. However, extensive temporary repairs approaching $20,000-25,000 typically justify schedule acceleration, particularly when financing options are available.

Factor in disruption costs when evaluating temporary versus permanent solutions. Temporary repairs often require multiple mobilizations and ongoing monitoring, while replacement provides long-term certainty. For critical buildings, the operational risk of repeated temporary repairs may justify replacement acceleration despite budget pressure.

The Bridge Strategy

Successful bridge strategies focus on minimum effective intervention rather than comprehensive temporary fixes. The goal is reliable function until planned replacement, not restoration to like-new condition. This approach often involves:

  • Targeted seam sealing for specific leak points
  • Drain cleaning and minor repairs
  • Limited membrane patching for damaged areas
  • Enhanced maintenance protocols to maximize remaining life

Avoid temporary solutions that approach 30-40% of replacement cost unless the intervention provides genuine 5-7 year life extension. In most cases, repairs exceeding this threshold indicate false economy where replacement acceleration provides better value.

Financing vs. Pay-As-You-Go Analysis

Multi-building roofing strategies must address fundamental financing decisions that affect both total program cost and annual budget impact. The choice between financing and pay-as-you-go approaches depends on interest rate environment, budget flexibility, and organizational financial policies.

Annual roofing budget planning must account for the total cost of capital when evaluating financing options. A $2 million roofing program financed over 10 years at current interest rates might cost $2.4 million total, while pay-as-you-go over 7 years costs $2 million but requires larger annual capital allocation.

The decision framework should consider budget flexibility and competing capital needs. Organizations with multiple large capital projects may prefer financing to preserve cash flow flexibility, while those with adequate annual capital capacity might choose pay-as-you-go to minimize total cost.

Interest rate environment significantly affects the analysis. Low-rate environments favor financing, particularly when investment returns exceed borrowing costs. However, rising rate environments often tip the analysis toward accelerated pay-as-you-go approaches.

Consider the operational risk of extended timelines. Pay-as-you-go strategies that stretch replacement schedules beyond building useful life increase emergency repair risk and potential consequential damage. Sometimes financing enables more appropriate replacement timing despite higher total cost.

Hybrid Financing Approaches

Many successful programs use hybrid financing that combines pay-as-you-go for immediate needs with financing for future phases. This approach might involve:

  • Current budget covers years 1-2 priorities
  • Financing enables years 3-5 replacements
  • Budget recovery allows pay-as-you-go for final phases

This strategy provides immediate action on critical buildings while maintaining financial flexibility for long-term planning.

Documentation and Board Presentation Strategy

Comprehensive assessment documentation with photos and condition ratings creates defensible capital planning that survives board and council scrutiny. The documentation package must tell a clear story that supports budget requests with objective data rather than subjective opinions.

Effective presentations focus on risk mitigation and fiscal responsibility rather than facility improvements. Board members respond better to "preventing $500,000 in interior damage and operational disruption" than "providing better roofs." Frame the investment as protecting existing assets rather than acquiring new capabilities.

Include total cost of ownership analysis that demonstrates the long-term financial benefits of proactive replacement versus reactive emergency response. Show historical emergency repair costs and project future savings from strategic replacement timing.

Visual documentation proves particularly powerful in board presentations. Before-and-after photos from similar projects, aerial imagery showing current conditions, and comparison photos between well-maintained and neglected roofs help non-technical board members understand the issues and solutions.

The Accountability Framework

Strong documentation creates accountability that extends beyond the initial capital planning process. Annual condition updates track progress and demonstrate stewardship of the approved investment. This ongoing documentation supports future capital requests and shows consistent attention to asset management.

Success metrics should include both immediate outcomes (leaks eliminated, emergency repairs reduced) and long-term indicators (asset life extension, avoided replacement costs). Regular reporting on these metrics reinforces the value of strategic capital planning and supports continued funding for the program.

Learning from Phase 1: Continuous Improvement

Multi-building strategies provide unique opportunities for continuous improvement as organizations learn from early projects and apply lessons to later phases. This learning process often results in significant improvements in both outcomes and costs as programs mature.

Common learning opportunities include specification refinements based on performance observations, contractor selection improvements, scheduling optimization, and project management enhancement. Issues discovered during first-year projects can be addressed in subsequent phases, resulting in better overall program outcomes.

Track performance metrics across all phases to identify trends and improvement opportunities. Metrics might include project delivery timeline adherence, change order frequency, warranty claim incidence, and long-term performance indicators.

Contractor relationships often improve throughout multi-year programs as both parties optimize working arrangements and project execution. This relationship development frequently results in cost improvements and quality enhancement in later phases.

Program Optimization

Successful programs establish regular review processes that assess both individual project performance and overall program effectiveness. These reviews might reveal opportunities to accelerate schedules when pricing proves favorable, adjust specifications based on performance data, or modify contractor selection criteria based on experience.

The flexibility to adapt strategy based on learning represents a key advantage of multi-year approaches over single large procurement events. Organizations can respond to changing conditions, incorporate new technologies, and refine approaches without abandoning overall strategic direction.

Implementing Your Multi-Building Strategy

Successful implementation of multi-building roofing strategies requires careful coordination of assessment, planning, procurement, and execution phases. The complexity of managing multiple projects across multiple years demands systematic approaches and clear accountability structures.

Establish project management protocols that provide consistent oversight across all phases while allowing flexibility for project-specific requirements. These protocols should address communication standards, approval processes, quality control procedures, and performance monitoring requirements.

Develop contractor selection criteria that emphasize both technical capability and organizational capacity for multi-year relationships. The lowest bidder may not provide the best value for complex multi-building programs that require sustained performance over several years.

Create stakeholder communication plans that keep all affected parties informed throughout the multi-year process. Regular updates on program progress, upcoming projects, and long-term schedules help maintain support for the strategic approach.

Long-term warranty protection becomes particularly important in multi-building programs where roofs are replaced across several years. Ensure warranty structures provide consistent protection and transferable coverage that survives organizational changes.

The difference between successful multi-building roofing strategies and reactive crisis management lies in systematic planning, objective prioritization, and disciplined execution. Organizations that invest in proper assessment, develop comprehensive strategies, and maintain consistent implementation often achieve 20-30% better outcomes at lower total cost than those pursuing building-by-building approaches.

Whether managing a school district with diverse educational facilities, a hospital system with critical care requirements, or a corporate campus with varied operational needs, the principles remain consistent: assess comprehensively, prioritize strategically, plan systematically, and execute consistently. The investment in strategic planning pays dividends throughout the multi-year implementation process and often reveals opportunities that reactive approaches miss entirely.

Tags: multi-building roofing strategy, campus roofing planning, school district roofing budget, hospital facility management, commercial roofing prioritization, capital planning framework, phased roofing replacement, building condition assessment, roofing budget allocation, facility maintenance planning
