FM Global Roofing Requirements: How Compliance Protects Your Insurance Coverage and Property Value
| By TriVAN Roofing | 28 min read
FM Global Data Sheet 1-29 establishes wind uplift, fire rating, and maintenance requirements for commercial roofs. Non-compliance can void coverage during claims. Learn FM approval standards, RoofNav verification, and documentation requirements.
Categories: Industry Insights
The facility manager at a Houston distribution center approved a $230,000 commercial roof replacement in 2024. The contractor provided competitive pricing, good references, and a fifteen-year manufacturer warranty. The project was completed on schedule with no apparent problems.
Fourteen months later, a severe thunderstorm with 85 mph straight-line winds damaged approximately 8,000 square feet of the roof. Wind uplift forces pulled sections of the membrane loose, allowing water intrusion that damaged inventory valued at $142,000. The facility manager filed a claim with FM Global expecting coverage for both roof repair and inventory loss, a total claim of approximately $387,000.
The FM Global adjuster's first question during site inspection wasn't about the storm or damage extent. It was "what FM approved assembly number was installed on this roof?" The facility manager provided the contractor's invoice and basic project photographs but had no documentation of an FM approved assembly number. The contractor had installed a quality TPO membrane system, but investigation revealed the insulation thickness and fastener pattern didn't match any FM approved assembly in the RoofNav database.
FM Global's position was clear. The policy required FM approved roof assemblies meeting Data Sheet 1-29 standards. The installed system, while professionally constructed, wasn't an approved assembly. The claim was denied. The facility owner paid $218,000 for roof repairs and $142,000 for inventory damage from their operating budget. The "savings" from not specifically requiring FM approved installation cost $360,000 in uncovered losses.
This scenario plays out multiple times annually across commercial properties with FM Global insurance. The pattern is consistent: facility managers focus on roof quality and warranty without understanding FM Global's specific approval requirements, contractors install quality systems that don't match FM approved assemblies, damage occurs from weather events the roof should have withstood, and claims are denied because installations don't meet FM Global compliance standards documented in Data Sheet 1-29.
This guide explains FM Global's commercial roofing requirements, how the approval system works, what documentation facility managers must maintain for insurance compliance, why FM Approved differs critically from FM Tested status, and how to ensure your roof installations protect both your property and your insurance coverage.
Understanding FM Global and Data Sheet 1-29
FM Global is a commercial and industrial property insurance company operating as a mutual insurer owned by its policyholders. Unlike traditional insurance carriers, FM Global emphasizes loss prevention and risk management, working proactively to prevent claims rather than just paying them after losses occur.
The FM Global Loss Prevention Philosophy
FM Global's business model centers on preventing property losses through engineering standards and regular inspections rather than accepting high claim frequency as normal cost of insurance operations. This approach means FM Global maintains detailed loss prevention data sheets establishing requirements for building systems including roofing, fire protection, electrical systems, and structural elements.
For building owners, this prevention-focused approach offers advantages and obligations. The advantage is that FM Global invests heavily in risk engineering, providing facility evaluations, recommendations, and guidance that improves property protection beyond what insurance coverage alone provides. FM Global risk engineers visit insured properties, identify vulnerabilities, and recommend improvements that prevent losses.
The obligation is that policyholders must comply with FM Global's loss prevention standards to maintain coverage. Unlike carriers that insure properties "as-is" and pay claims regardless of building condition, FM Global requires policyholders to meet specific standards. Non-compliance can result in coverage exclusions, increased premiums, or policy non-renewal.
For commercial roofing specifically, this means facility managers with FM Global insurance must understand and comply with Data Sheet 1-29 requirements. The insurance relationship isn't passive where you pay premiums and expect claim coverage regardless of roof condition. It's active where compliance with FM standards is condition of coverage.
What Data Sheet 1-29 Covers
FM Global Data Sheet 1-29 titled "Roof Assemblies and Steep Slope Roofs" establishes requirements for commercial roof systems including wind uplift resistance classifications, fire resistance requirements, hail resistance standards, material compatibility requirements, installation methods and quality standards, inspection and maintenance obligations, and documentation requirements for compliance verification.
The data sheet is updated periodically reflecting testing results, field performance data, and evolving building science. The current version as of 2026 emphasizes complete assembly approval rather than just component approval, enhanced wind uplift requirements for high-wind zones, documentation of proper installation methods, and regular inspection programs with documented findings.
Facility managers don't need to memorize Data Sheet 1-29's technical details, but they absolutely must understand that FM Global has specific requirements beyond generic "quality roof installation." Those requirements are mandatory for insurance compliance, not optional recommendations. Working with contractors who understand FM Global requirements and can provide compliant installations with proper documentation is essential.

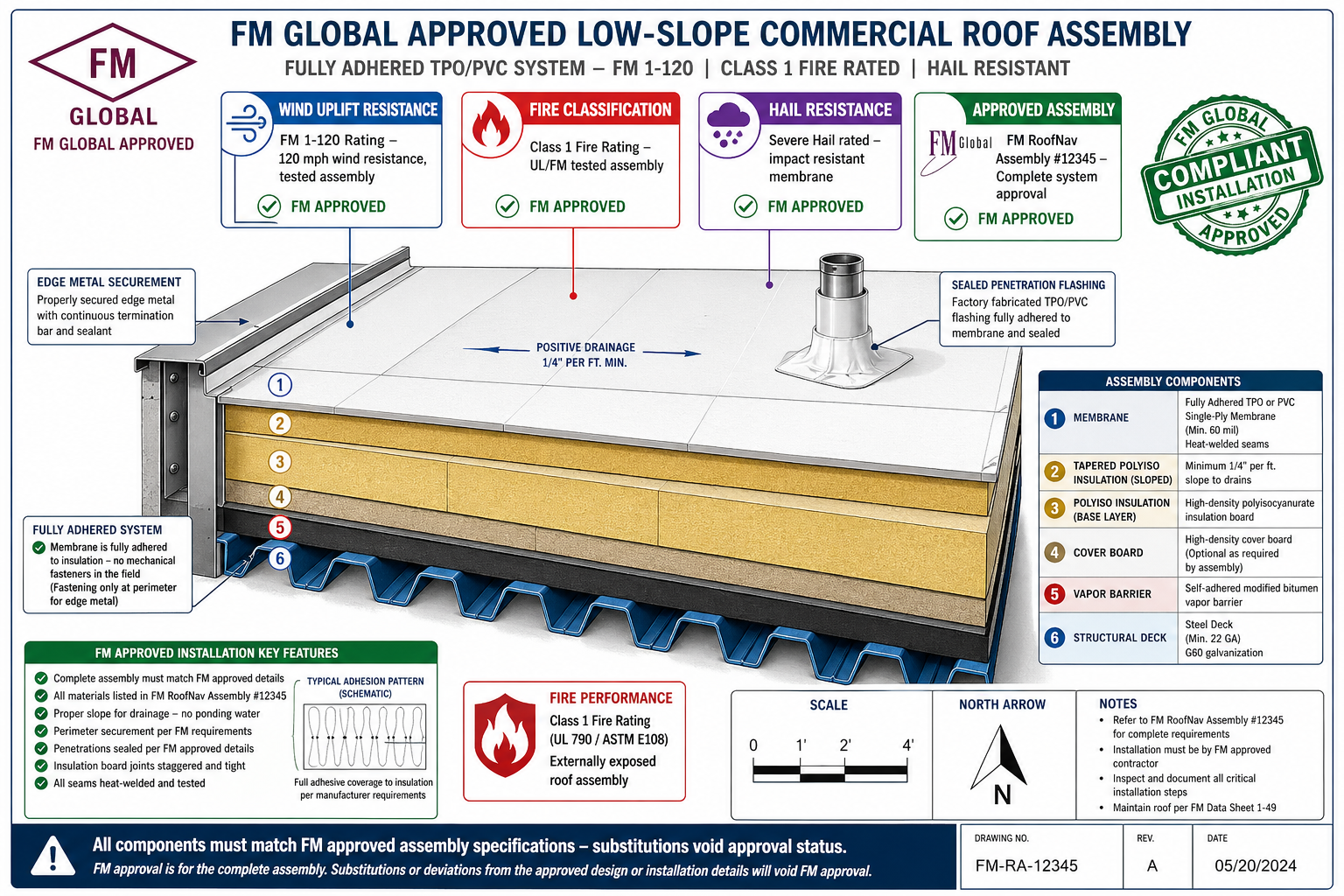

Understanding FM Global Wind Uplift Requirements
Wind uplift forces attempt to pull roof systems off buildings during high-wind events. FM Global classifies roof assemblies based on tested resistance to these uplift forces, with ratings corresponding to specific wind speeds the assembly can withstand.

How Wind Uplift Ratings Are Determined
FM Global tests complete roof assemblies (not just individual components) in wind uplift simulators applying progressively increasing vacuum pressure to the assembly until failure occurs. The pressure at failure is converted to equivalent wind speed creating the rating classification.

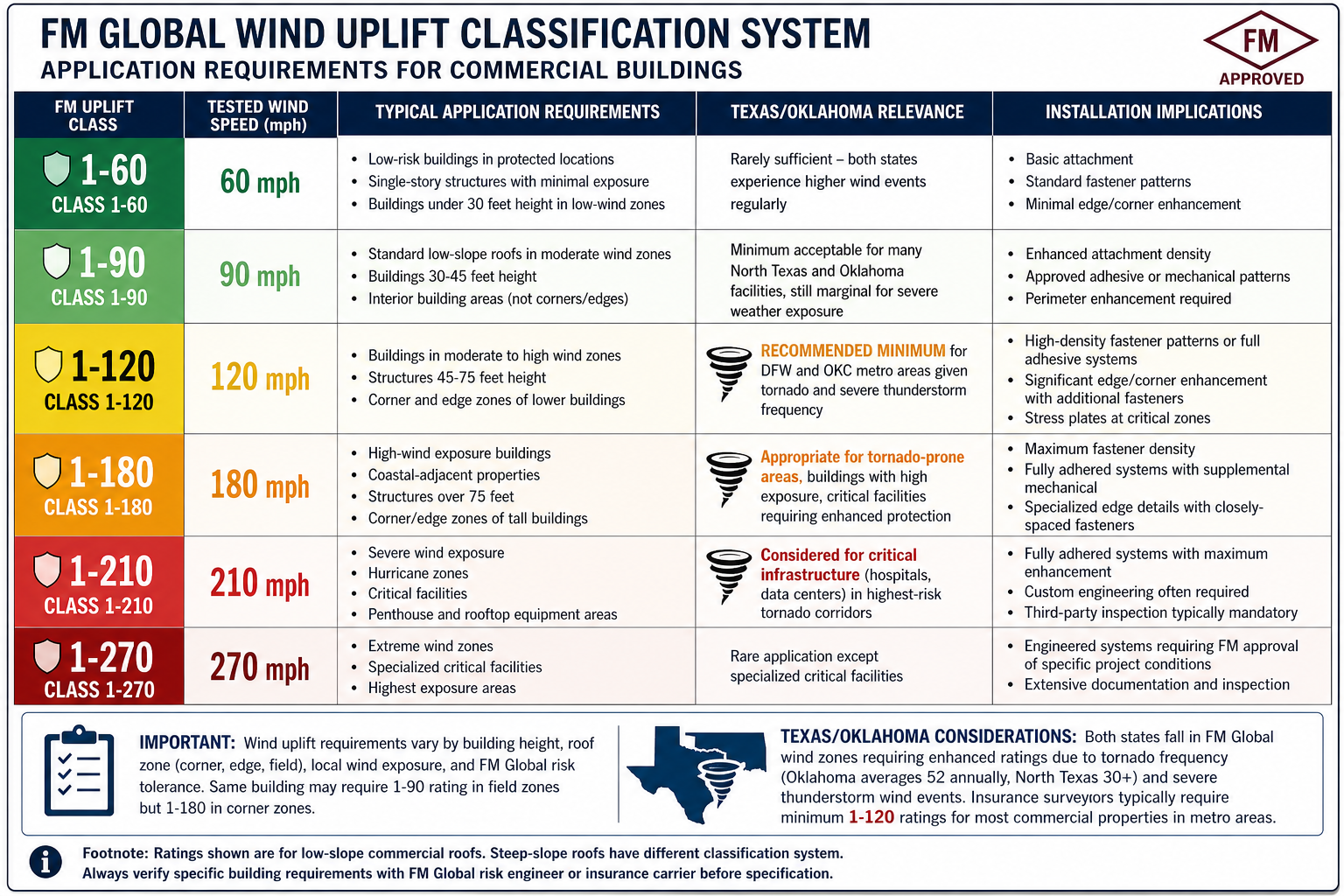

Ratings are expressed as "1-XX" where XX represents the tested wind speed in miles per hour. Common classifications include 1-60 (60 mph resistance), 1-90 (90 mph), 1-120 (120 mph), 1-180 (180 mph), 1-210 (210 mph), and 1-270 (270 mph). Higher numbers indicate stronger wind resistance requiring more robust attachment methods, higher fastener densities, or full adhesive systems.
The critical point is that ratings apply to complete assemblies tested as installed. A membrane with excellent wind resistance performs only as well as its attachment to the deck. If fastener density is inadequate or adhesive coverage is insufficient, actual wind resistance may be far below the membrane's tested capability. FM approval requires that all components and installation methods match the tested assembly exactly.
Required Ratings by Building Type and Location
FM Global determines required wind uplift ratings based on building location (geographic wind zone), building height (taller buildings experience higher wind forces), roof zone (corners and edges experience higher uplift than field areas), and building importance (critical facilities may require enhanced ratings).
Texas and Oklahoma fall into wind zones requiring enhanced ratings due to tornado frequency and severe thunderstorm activity. Oklahoma averages 52 tornadoes annually ranking third nationally for tornado frequency. North Texas averages 30+ tornadoes per year with additional severe thunderstorm straight-line wind events capable of producing 80-100 mph winds.
For these regions, FM Global typically requires minimum 1-90 ratings for low-rise buildings in protected locations, 1-120 ratings for standard commercial buildings in metro areas (this is common requirement for DFW and Oklahoma City facilities), 1-180 ratings for buildings over 60 feet height or in high-exposure locations, and 1-210 or higher for critical facilities, penthouse areas, and specialized high-risk buildings.
The same building may require different ratings for different roof zones. Field areas (interior sections away from edges) might require 1-120, while corner and edge zones within 10-20 feet of roof perimeter might require 1-180 due to concentrated wind forces at building corners.
Facility managers should never assume a specific rating is appropriate without verification. The requirement for your specific building depends on multiple factors that FM Global risk engineers evaluate during property surveys. Always confirm required ratings before specification or bid solicitation.
Common Wind Uplift Compliance Failures
Even when contractors understand FM requirements, several common failures result in inadequate wind resistance including incorrect fastener density (specifications require 1 fastener per 2 square feet but contractor installs 1 per 4 square feet reducing attachment strength 50%), adhesive coverage gaps (fully adhered systems require complete coverage but contractor leaves uncovered areas reducing effective attachment), edge and corner enhancement omissions (higher-rated corner zones require supplemental fasteners but contractor uses same pattern throughout), and component substitutions (approved assembly specifies fastener type but contractor substitutes "equivalent" fasteners not tested in that assembly).
These installation deviations often aren't visible after roof completion. The membrane looks properly installed from casual observation, but the underlying attachment doesn't match FM approved specifications. Wind damage reveals the deficiency when uplift forces exceed what the actual (not approved) installation can resist.
Where mission-critical facilities like data centers where FM Global requirements are typically most stringent implement compliance verification, those facilities often require third-party inspection during installation documenting that fastener density, adhesive coverage, and component specifications match approved assembly requirements exactly.

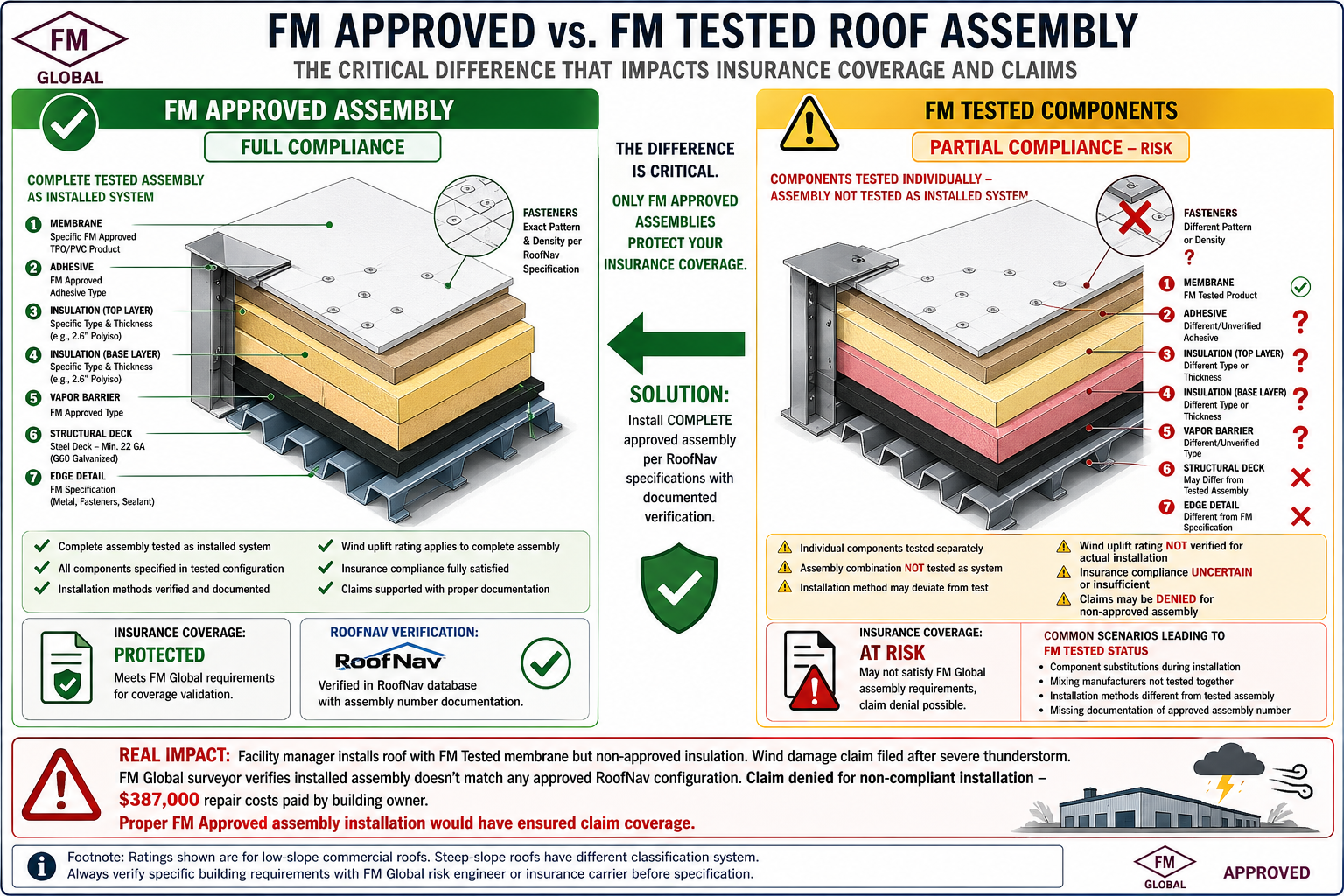

FM Approved vs FM Tested: Critical Distinction
Many facility managers and even some contractors don't understand the critical difference between "FM Approved" and "FM Tested" status. This distinction directly affects insurance compliance and claim outcomes.

What FM Approved Actually Means
"FM Approved" indicates that a complete roof assembly has been tested as a system with all components installed together exactly as they would be on an actual building. The approval covers the specific combination of deck type, vapor barrier, insulation type and thickness, insulation attachment method, membrane product and thickness, membrane attachment method (fastener pattern or adhesive coverage), edge detail configuration, and fastener/plate specifications.
Each approved assembly receives an assembly number documented in FM Global's RoofNav database. Contractors and facility managers can search RoofNav by manufacturer, system type, wind rating, fire classification, and other parameters to identify approved assemblies meeting project requirements.
When contractor installs an FM Approved assembly, they're replicating the exact configuration that was tested and proven to meet the stated wind uplift rating, fire classification, and other performance criteria. The approval is valid only when all components and installation methods match the tested assembly exactly.
What FM Tested Means (and Doesn't Mean)
"FM Tested" indicates that individual components or materials have been tested but the complete assembly combination hasn't been approved. For example, a membrane might be FM Tested showing it has good inherent properties, but that doesn't mean any assembly using that membrane is FM Approved.
Contractors sometimes claim they're installing "FM approved materials" when they mean individual components are FM Tested. This is insufficient for FM Global compliance. The insurance requirement is for FM Approved assemblies, not just FM Tested components.
The problem with FM Tested-only installations is that component interaction matters enormously for performance. A membrane performs differently when adhered directly to polyisocyanurate insulation versus mechanically attached over gypsum cover board. Fastener pull-through resistance varies with deck thickness and insulation density. Fire performance depends on complete assembly composition, not just membrane properties.
Installing quality FM Tested components in non-tested combinations creates roof systems with unknown actual performance. They might perform adequately, or they might fail at wind speeds well below what facility managers and insurance carriers expect. Without testing verification, there's no way to know.
How Substitutions Void FM Approval
A common scenario that converts FM Approved assemblies to non-approved installations involves component substitutions during construction. The specification calls for FM Approved Assembly #12345 which includes specific insulation product at 3-inch thickness. During procurement, contractor discovers that insulation is backordered but a "similar" product is available.
The contractor substitutes the alternative insulation without realizing this voids the FM approval. The new insulation might have similar R-value and even similar physical properties, but it wasn't part of the tested assembly. The combination of that particular insulation with the specified membrane, fasteners, and deck hasn't been tested. The assembly is no longer FM Approved even though every individual component is quality material.
This substitution problem extends to fasteners, adhesives, cover boards, and even seemingly minor components. FM approval is system-specific. Any deviation from the approved assembly specification requires verification that the modified combination is also FM Approved under a different assembly number. Simply assuming "equivalent" components produce equivalent performance violates FM requirements.
Facility managers should require contractors to document the specific FM Approved assembly number in bid proposals and again at project completion. Any changes from the specified assembly during construction must be approved in advance with verification that the modified configuration has its own FM approval.
Fire Classification and Hail Resistance Requirements
Beyond wind uplift, FM Global requires specific fire classifications and hail resistance depending on building characteristics and hazard exposure.
Fire Classification System
FM Global uses fire classifications including Class 1 (also called Class A or severe exposure rating) for highest fire resistance requirements typically required for buildings with combustible contents or high fire hazard exposure, Class 2 (Class B) for moderate fire resistance, and Non-Combustible for buildings with minimal fire hazard where fire spread across roof surface is primary concern.
Classification testing evaluates burning brand test (resistance to burning embers landing on roof), spread of flame test (fire propagation across membrane surface), flying brand test (resistance to larger burning debris), and rain test (continued water resistance after fire exposure).
Most commercial facilities with FM Global coverage require minimum Class 1 fire rating. This requirement is typically easier to meet than wind uplift requirements because modern commercial roofing membranes (TPO, PVC, EPDM over appropriate substrates) generally achieve Class 1 ratings in approved assemblies.
The fire classification applies to the complete assembly, not just the membrane. Even fire-resistant membranes can fail fire testing if installed over highly combustible insulation without proper barrier layers. FM approved assemblies document tested fire performance for complete assembly combinations.
Hail Resistance Standards
FM Global classifies roof assemblies for hail resistance using categories including Non-rated (no specific hail resistance testing), Moderate Hail (resistant to typical hail events up to 1.25 inch diameter), Severe Hail (resistant to large hail up to 1.75-2 inch diameter), and Very Severe Hail (maximum tested resistance for extreme hail events).
Texas and Oklahoma both experience significant hail exposure. The "hail alley" corridor running through northern Texas and central Oklahoma produces frequent large hail events. DFW metroplex averages 9-12 hail days annually with events exceeding 2 inches diameter occurring most years. Oklahoma City experiences similar frequency with documented hail events reaching tennis ball and even softball sizes.
For properties in these hail-prone regions, FM Global often requires minimum Severe Hail rated assemblies. This typically means impact-resistant membranes (reinforced TPO or PVC), adequate insulation cushioning beneath membrane to absorb impact energy, and assembly combinations tested for hail impact resistance.
Hail ratings matter for claims. After significant hail events, FM Global adjusters verify whether installed assemblies met required hail ratings. Non-rated or inadequately rated systems may face coverage questions if damage occurs from hail events within the assembly's tested resistance level. If your assembly should have withstood 1.75 inch hail but failed during a 1.5 inch hail event, the claim outcome becomes complicated.
The RoofNav System: Verifying Approved Assemblies
FM Global maintains RoofNav, an online database of approved roof assemblies that facility managers and contractors use to identify compliant systems and verify assembly numbers for documentation.
How to Use RoofNav Effectively
RoofNav is accessible through FM Global's website allowing users to search approved assemblies by manufacturer name, membrane type (TPO, PVC, EPDM, modified bitumen, etc.), deck type (steel, concrete, wood), wind uplift rating required, fire classification needed, and insulation type preferences.
Search results display assembly numbers with detailed specifications including every component in the assembly, installation method for each layer, fastener types and density patterns, edge detail requirements, and tested performance ratings for wind, fire, and hail.
Facility managers should use RoofNav during specification development to identify approved assemblies meeting project requirements before bid solicitation. Including specific FM approved assembly numbers in specifications ensures contractors price compliant systems rather than proposing alternatives requiring change orders or substitution reviews later.
During contractor selection, facility managers should require bidders to identify which specific FM approved assembly numbers they propose to install. This creates documentation trail and forces contractors to verify assembly approval before bidding rather than discovering compliance issues during construction.
Common RoofNav Mistakes
Several common mistakes when using RoofNav lead to compliance problems including searching by membrane only without specifying complete assembly (finds many options but doesn't account for insulation, fasteners, and other components affecting suitability), assuming similar assemblies are interchangeable (Assembly #12345 and #12347 might differ only in fastener spacing but that difference matters for wind rating), not verifying assembly number during project completion (contractor claims to have installed approved assembly but provides no assembly number for verification), and relying on contractor's assertion that assembly is "FM approved" without independent RoofNav verification.
The most effective approach is for facility managers or their consultants to identify appropriate assemblies during design phase, specify those assembly numbers explicitly, require contractors to confirm those exact assemblies in proposals, and verify assembly numbers in completion documentation. This multi-step verification prevents miscommunication and ensures installation actually matches FM requirements.

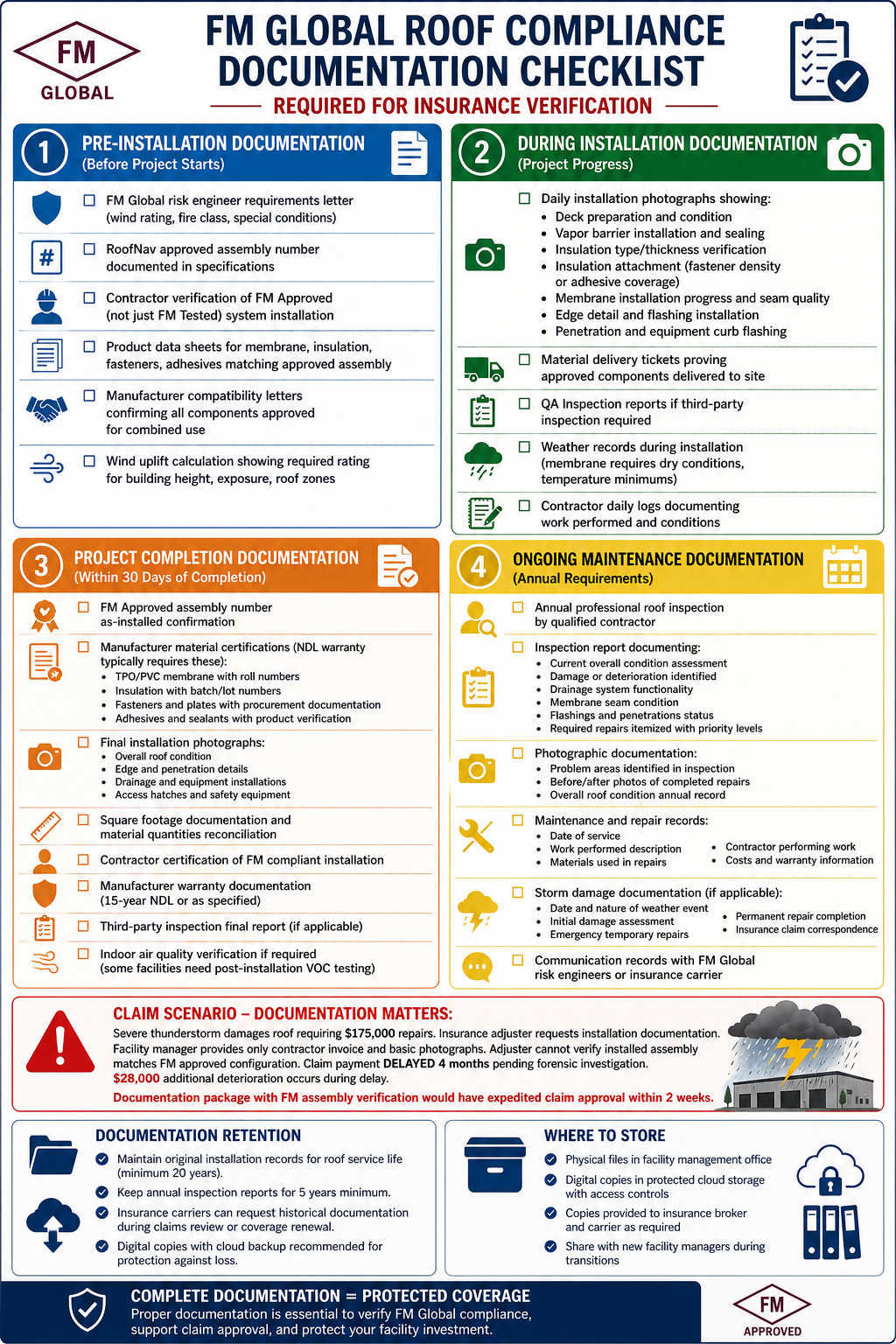

Documentation Requirements for Insurance Compliance
Comprehensive documentation is essential for demonstrating FM Global compliance during insurance inspections and supporting claims if damage occurs. Missing or incomplete documentation can jeopardize coverage even when physical installation is correct.

Installation Documentation Package
Facility managers should require contractors to provide complete installation documentation within 30 days of project completion including FM approved assembly number as installed with RoofNav printout showing assembly specifications, manufacturer material certifications for membrane (product name, thickness, roll numbers), insulation (type, thickness, R-value, batch numbers), fasteners and plates (specifications and quantities), and adhesives and sealants (product names and coverage rates).
Installation photographs should document deck condition before membrane installation, insulation installation showing thickness and attachment, membrane installation progress, edge details and perimeter securement, penetration flashings and equipment curbs, and completed roof conditions from multiple angles.
Additional required documentation includes contractor certification that installation followed FM approved assembly specifications exactly, manufacturer NDL warranty (typically 15-year No Dollar Limit warranty for FM approved installations), third-party inspection reports if QA inspection was required, and material delivery tickets proving approved products were delivered to site.
This documentation package should be maintained in permanent facility files accessible during FM Global surveys or claim investigations. Digital copies with cloud backup provide protection against document loss.
Annual Inspection Documentation
FM Global Data Sheet 1-29 requires annual professional roof inspections documenting current conditions. These aren't casual walk-throughs but systematic inspections by qualified roofing professionals documenting overall roof condition assessment, damage or deterioration identified, drainage system functionality and any ponding water areas, membrane seam condition and any separation or opening, flashing conditions at penetrations, equipment, and edges, and required repairs itemized with priority classifications.
Inspection reports should include dated photographs showing problem areas identified, overall roof condition for year-over-year comparison, and completed repairs from previous inspection recommendations. The photographic record creates timeline of roof condition helping FM Global surveyors understand maintenance history and remaining service life.
Facility managers should implement systematic annual inspection programs scheduling inspections during similar seasons each year (spring or fall typically best for commercial roofs in Texas/Oklahoma) and maintaining inspection files documenting inspection dates, findings, repair recommendations, actual repairs completed with dates and costs, and deferred maintenance with justifications.
Where preventive maintenance programs with FM-compliant documentation satisfying annual inspection requirements are established, those programs create documentation trail demonstrating responsible property stewardship that FM Global values. Facilities with documented regular maintenance typically receive better treatment during claims than facilities with no maintenance records.
Storm Damage Documentation
When storm damage occurs, comprehensive documentation becomes critical for claim support. Facility managers should document date, time, and nature of weather event (wind speed, hail size from weather service records), immediate damage assessment with photographs before any temporary repairs, emergency temporary weatherproofing measures with dates and costs, permanent repair scope once damage is fully assessed, and all communication with FM Global adjusters including site visits and requests for information.
The better the documentation, the faster claim processing proceeds. Where hail damage insurance claims where FM approved assembly documentation expedites adjuster approval are filed with complete installation records, assembly numbers, and maintenance documentation, those claims typically resolve in 2-4 weeks versus 2-4 months for claims requiring investigation of undocumented installations.
Real-World Compliance Failures and Consequences
Understanding theoretical requirements helps, but examining actual compliance failures illustrates why FM Global standards matter and what happens when requirements aren't met.
Case Study: Component Substitution Voids Approval
A Dallas warehouse facility installed new commercial roof in 2023 specified as FM Approved Assembly requiring 1-120 wind uplift rating. The contractor installed quality TPO membrane with proper edge details and good workmanship. During installation, the specified polyisocyanurate insulation thickness was reduced from 3 inches to 2.5 inches to meet budget constraints, a seemingly minor change that facility manager approved assuming it wouldn't significantly affect performance.
In 2025, severe thunderstorm with measured 95 mph winds caused wind uplift damage pulling approximately 12,000 square feet of membrane loose. The facility filed $287,000 claim with FM Global for roof repair and interior damage from water intrusion.
FM Global's investigation revealed the insulation substitution. The approved assembly specified 3-inch insulation because testing showed that thickness was necessary for the fastener pull-through resistance achieving 1-120 rating. The 2.5-inch insulation reduced pull-through resistance below tested levels. The actual installed assembly had no FM approval and likely couldn't withstand the 120 mph winds it was supposed to resist.
FM Global denied the claim for non-compliant installation. The roof should have withstood 95 mph winds with 1-120 rated assembly, but the substituted configuration was never tested and apparently failed below its required resistance. The facility owner paid $287,000 in repairs from operating funds.
The lesson is that even minor component changes can void FM approval. The 0.5-inch insulation thickness difference seemed insignificant but fundamentally changed assembly performance. Always verify that any modifications maintain FM approval under a different assembly number.
Case Study: Missing Documentation Delays Claim
An Oklahoma City retail facility suffered hail damage in 2024 requiring $142,000 roof repair. The facility manager knew the roof had been installed with "FM approved materials" three years earlier and filed claim expecting straightforward approval.
FM Global adjuster requested installation documentation including FM approved assembly number. The facility manager could only provide contractor invoice listing "TPO roof system" with no assembly number, manufacturer warranties, or installation specifications. The original contractor had gone out of business and records weren't available.
FM Global hired forensic roofing consultant to investigate the installation. The consultant performed destructive testing pulling samples to verify insulation type, thickness, and fastener density. The investigation took four months and cost $18,000. During this period, temporary repairs were needed adding $12,000 expense.
The investigation eventually confirmed the installation matched an FM approved assembly. FM Global paid the claim minus the $18,000 investigation cost which they argued was necessary due to missing documentation. The temporary repairs during investigation weren't covered. What should have been simple two-week claim resolution took four months and cost the facility $30,000 in uncovered expenses.
Proper documentation at installation completion would have prevented the entire problem. Assembly numbers and installation records aren't optional nice-to-have paperwork. They're essential insurance compliance documentation that directly affects claim outcomes.
Case Study: Inadequate Maintenance Records Affect Coverage
A San Antonio distribution center filed $96,000 wind damage claim in 2025 after severe thunderstorm. FM Global adjuster's inspection revealed multiple pre-existing maintenance issues including open seams from previous wind events not properly repaired, clogged drains causing ponding water, loose edge flashing from deferred maintenance, and penetration flashings showing water intrusion damage predating the storm event.
The facility manager had no documentation of roof inspections or maintenance for the five years since installation. FM Global's position was that lack of proper maintenance contributed to damage severity. Pre-existing open seams and loose flashing made the roof more vulnerable to wind damage than properly maintained FM approved assembly would have been.
FM Global paid $52,000 of the claim attributing the balance to pre-existing conditions and maintenance failures. The facility manager disputed the allocation but had no inspection records or maintenance documentation to counter FM Global's assessment.
Annual inspections with documented repairs would have created record showing responsible maintenance. FM Global accepts that roofs require periodic repairs, but they expect facility managers to address issues promptly rather than allowing deterioration to progress unchecked. Documentation proves you met this expectation.
Strategies for Ensuring FM Global Compliance
Facility managers can implement systematic approaches ensuring their roofing installations and maintenance programs meet FM Global requirements protecting insurance coverage.
Work With FM-Knowledgeable Contractors
Not all commercial roofing contractors understand FM Global requirements. Some have never worked on FM insured properties and don't appreciate the approval system's nuances. Selecting contractors with documented FM Global experience significantly reduces compliance risk.
During contractor qualification, ask how many FM Global compliant installations they've completed in past three years, whether they have staff trained on RoofNav system and assembly verification, what their process is for ensuring installed systems match FM approved assemblies exactly, and how they document installations for FM compliance verification.
Contractors familiar with FM requirements understand they can't substitute components, appreciate that assembly numbers must be documented, know that installation methods must match approved specifications exactly, and provide comprehensive documentation packages without being asked because they understand insurance implications.
Where commercial roofing services with comprehensive FM Global compliance documentation and installation are prioritized, those contractors invest in training, systems, and quality control specifically addressing FM requirements rather than treating them as afterthought specifications that can be approximated.
Include FM Requirements in Specifications
Generic roofing specifications that don't explicitly address FM Global requirements often result in compliant installations by accident rather than design. Effective specifications include required wind uplift rating, fire classification, and hail resistance specific to the building, specific FM approved assembly numbers identified through RoofNav research as acceptable options, requirement that contractor verify proposed assembly is FM approved and provide assembly number in bid, prohibition on component substitutions without written approval verifying substitute maintains FM approval, and detailed documentation requirements including assembly verification, material certifications, and photographs.
Some facility managers include language requiring contractors to warrant that installations comply with FM Global Data Sheet 1-29 and that any non-compliance will be corrected at contractor expense. This contractual obligation creates additional motivation for contractor attention to FM requirements.
Implement Third-Party Inspection for Critical Projects
For large projects, critical facilities, or situations where facility managers lack expertise to verify FM compliance, third-party roof inspection during installation provides independent verification. Third-party inspectors verify materials delivered match approved assembly specifications, fastener density and patterns match FM requirements, adhesive coverage is complete and adequate, edge details are installed per approved methods, and final installation matches specified FM approved assembly.
The inspection cost (typically $2,000-$5,000 for standard commercial projects) is modest compared to claim denial risk from non-compliant installation. For warehouse and distribution facilities where FM Global coverage is common for inventory protection with potential claim values in millions of dollars, inspection costs are trivial insurance against coverage jeopardy.
Maintain Systematic Documentation Files
Create comprehensive roof compliance files as part of facility management standard procedures. Files should include pre-construction documentation (FM requirements letter, RoofNav assembly research, specifications), installation documentation (assembly numbers, material certs, photographs, completion reports), manufacturer warranty documentation, annual inspection reports with photographs, maintenance and repair records with dates and descriptions, storm damage documentation if applicable, and all correspondence with FM Global or insurance carriers.
Organize files chronologically and maintain both physical and digital copies. When facility managers transition, these files should be part of formal handoff ensuring successor managers understand roof compliance history and obligations.
Where emergency roof repairs completed with FM-compliant materials and methods maintaining insurance approval are necessary, even temporary or emergency work should be documented with photographs and repair records maintaining compliance file completeness.
Geographic Considerations for Texas and Oklahoma
Commercial properties in Texas and Oklahoma face specific FM Global compliance considerations due to regional hazard exposure.
Wind and Tornado Exposure
Both states experience significant tornado and severe thunderstorm activity requiring enhanced wind uplift ratings. Where commercial properties in DFW and Oklahoma where tornado and severe weather exposure requires enhanced FM wind ratings are common, facility managers should expect minimum 1-120 requirements for most commercial buildings with 1-180 requirements for taller structures or high-exposure locations.
The "tornado alley" corridor affects insurance requirements across both states. FM Global risk engineers factor tornado frequency into building-specific wind rating requirements. Properties in Oklahoma City, Tulsa, Dallas, Fort Worth, and surrounding areas typically receive more stringent wind requirements than properties in lower-risk regions.
Hail Exposure Considerations
The hail corridor running through north Texas and central Oklahoma creates severe hail exposure affecting FM Global hail resistance requirements. Facilities in DFW metroplex, Oklahoma City metro, and Tulsa area commonly require Severe Hail or Very Severe Hail rated assemblies due to documented large hail frequency.
Hail resistance becomes particularly important for facilities with extensive HVAC equipment, solar arrays, or other rooftop equipment vulnerable to hail damage. FM Global evaluates not just roof membrane hail resistance but also equipment protection and potential for hail-damaged equipment to create additional roof damage through falling debris or oil leaks.
Insurance Market Considerations
Texas and Oklahoma have experienced commercial property insurance market volatility in recent years with carriers withdrawing from markets, premium increases of 30-50% for some properties, and increased scrutiny of building conditions during underwriting. This market tightening makes FM Global compliance even more critical.
FM Global's loss prevention approach and policyholder selectivity means they maintain more stable coverage than many carriers during hard market cycles. But this stability comes with strict compliance expectations. Properties that meet FM Global standards maintain coverage and relatively stable premiums while properties with compliance issues face coverage questions or non-renewal.
Facility managers should view FM Global compliance as competitive advantage during tight insurance markets. Properties with documented compliant roofs, regular maintenance, and comprehensive risk management are preferred risks that carriers want to retain.
Conclusion
FM Global Data Sheet 1-29 establishes comprehensive requirements for commercial roof systems going well beyond general quality installation standards. The requirements cover wind uplift resistance through tested and approved assemblies rated from 1-60 to 1-270 based on building exposure and hazard zones, fire classifications ensuring roofs resist burning brands and fire spread across membrane surfaces, hail resistance appropriate for regional exposure with Severe Hail ratings common in Texas and Oklahoma, and maintenance documentation demonstrating responsible property stewardship through regular inspections and prompt repairs.
The critical distinction between FM Approved assemblies (complete systems tested as installed) and FM Tested components (individual materials tested separately) directly affects insurance coverage. Only FM Approved assemblies documented through RoofNav assembly numbers satisfy FM Global requirements. Installing quality FM Tested components in non-approved combinations creates coverage risk and potential claim denials.
Documentation requirements are comprehensive and mandatory including installation records with FM assembly numbers and material certifications, completion photographs documenting proper installation methods, annual professional inspection reports with condition assessment and repair recommendations, maintenance records showing prompt completion of identified repairs, and storm damage documentation supporting claims when weather events cause damage.
Real-world compliance failures demonstrate serious financial consequences. Component substitutions void FM approval creating claim denial risk for damage that should have been covered. Missing documentation delays claims by months requiring expensive forensic investigation to verify compliance. Inadequate maintenance records allow FM Global to attribute damage to pre-existing conditions rather than covered weather events. These failures cost hundreds of thousands of dollars in uncovered repairs and business interruption.
Texas and Oklahoma facilities face enhanced requirements due to tornado and severe hail exposure. Most commercial properties in DFW, San Antonio, Oklahoma City, and Tulsa areas require minimum 1-120 wind uplift ratings with 1-180 or higher for taller buildings and critical facilities. Severe Hail ratings are commonly required due to frequent large hail events in the hail corridor affecting both states.
Effective compliance strategies include working with contractors who understand FM Global requirements and can provide proper documentation, including explicit FM requirements in specifications with specific assembly numbers and documentation obligations, implementing annual inspection programs creating maintenance documentation trail, maintaining comprehensive compliance files with installation records and inspection reports, and considering third-party inspection for critical projects or when internal expertise is limited.
FM Global compliance isn't optional for facilities with FM Global insurance. It's mandatory condition of coverage. Treating compliance as checklist item to delegate to contractors without verification creates substantial risk. Facility managers must understand requirements, verify contractor compliance, maintain documentation, and implement maintenance programs demonstrating responsible risk management.
The investment in proper FM Global-compliant installation and documentation is modest compared to potential consequences of non-compliance. Installation costs might be 3-5% higher for verified FM Approved assemblies versus generic "quality roofing" approaches. But that small incremental investment protects hundreds of thousands or millions in potential claim coverage, prevents premium increases from compliance deficiencies, maintains property value through documented quality installation, and demonstrates risk management sophistication that insurance carriers value during underwriting.
Call 877-487-4826 to discuss FM Global-approved commercial roofing installations and maintenance programs ensuring your insurance coverage remains valid and your property stays protected across Texas and Oklahoma.
Tags: FM Global roofing requirements, FM Global Data Sheet 1-29, commercial roof insurance compliance, FM approved roofing systems, wind uplift ratings commercial roofs, FM Global RoofNav, commercial property insurance requirements, roof system FM approval, FM Global claim requirements
