Data Center Roof Protection: Preventing Hail Damage in Texas and Oklahoma

| By TriVAN Roofing | 27 min read

Data Center Roof Protection: Preventing Hail Damage in Texas and Oklahoma

Texas data centers face frequent hail threats requiring impact-resistant roofing systems, redundant drainage, and emergency response protocols. Class 4 membranes, FM-approved assemblies, and uptime-focused design protect mission-critical facilities from storm damage and prevent costly downtime.

Categories: Industry Insights

The data center facility manager in Richardson received the severe thunderstorm warning at 2:47 PM on a Tuesday in April. Hail up to 2.5 inches was possible within the next hour. The colocation facility housed equipment for seventeen clients operating services that couldn't tolerate downtime. Monthly penalties for SLA violations ran into hundreds of thousands of dollars.

The roof had been installed three years earlier during the initial facility construction. The architect specified a standard TPO membrane system that met code requirements and looked competitive on the construction budget. Nobody at that time had focused specifically on hail resistance or what would happen if severe weather damaged the roof while $40 million in IT equipment operated below.

When golf-ball-sized hail started hammering the roof at 3:15 PM, facility operations staff could hear the impacts through the ceiling tiles in the office areas. The pounding continued for twelve minutes. When it stopped, the facility manager climbed to the roof to assess damage. The TPO membrane showed dozens of impact points where hail had hit hard enough to crack the reinforcement and puncture through the membrane layers. Water was already finding its way into the roof assembly.

Emergency repairs prevented immediate equipment damage, but the incident cost the facility operator in ways that went beyond repair bills. Client confidence was shaken. Insurance premiums increased. The facility's reputation as reliable infrastructure was questioned. Most importantly, the operator realized their roof system had been designed for code compliance rather than operational resilience. In a region that averages 9-12 hail events annually, that was an expensive oversight.

Data centers in Texas and Oklahoma face unique roofing challenges that differentiate these facilities from typical commercial buildings. Uptime requirements make weather-related failures unacceptable. Equipment values make even minor water intrusion catastrophically expensive. Client contracts make service interruptions legally and financially costly. These realities demand roof systems engineered specifically for severe weather resilience rather than generic commercial roofing that happens to cover data center buildings.

This guide explains how data center operators and construction teams can design, install, and maintain roofing systems that protect mission-critical facilities from the hailstorms that are statistically inevitable in the Texas and Oklahoma climate.

Why Texas and Oklahoma Data Centers Face Elevated Hail Risk

Understanding the specific weather threats helps explain why data center roofing requirements in this region differ from facilities in other markets.

Regional Hail Frequency and Severity

The Dallas-Fort Worth metroplex averages 9-12 hail events annually, making North Texas one of the highest hail-frequency regions in the United States. Oklahoma City faces similar exposure with 8-11 events per year. San Antonio sees 5-7 annual events, still well above national averages for major metropolitan areas.

These aren't just nuisance hailstorms producing pea-sized ice that melts on impact. Texas and Oklahoma hailstorms regularly produce golf-ball to baseball-sized hail (1.75 to 2.75 inches in diameter) with documented events reaching softball size (4+ inches). Hail of this magnitude carries tremendous kinetic energy. A 2-inch diameter hailstone falling at terminal velocity hits a roof surface with the same impact energy as dropping a 2-pound steel ball from 20 feet.

Standard commercial roofing membranes were not designed to withstand impacts of this magnitude. Single-ply TPO and PVC membranes commonly used in commercial construction achieve UL 2218 Class 1 or Class 2 impact resistance ratings, meaning they withstand 1.25 to 1.5-inch diameter steel ball drops from 12 to 15 feet. These systems fail when exposed to the 2+ inch hail that North Texas experiences multiple times per year.

The concentration of hail events during April through June creates additional challenges for data center operators. This spring severe weather season coincides with peak cooling loads as Texas temperatures climb. Roof damage during high-demand periods increases operational stress and complicates emergency repair scheduling.

Data Center Construction Boom in High-Hail Regions

The Texas data center market has experienced explosive growth over the past decade. Dallas-Fort Worth has become one of the top five data center markets in North America, with major hyperscale facilities from cloud providers and extensive colocation campus development. San Antonio is emerging as a secondary market with strong growth. Oklahoma City attracts data center development through competitive power pricing and central geographic location.

This construction boom places hundreds of millions of dollars in data center infrastructure directly in the path of America's most active hail region. Many facilities under construction today are being designed by architects and engineers from markets where hail is not a significant design consideration. Specifications developed for data centers in Northern California, the Pacific Northwest, or European markets don't account for the hail exposure that Texas and Oklahoma facilities face.

The result is mission-critical facilities with roof systems adequate for their original design markets but inappropriate for Texas severe weather. When these facilities experience their first significant hail event, operators discover their infrastructure has vulnerabilities that weren't considered during initial design.

Operational Consequences of Roof Failure in Data Centers

Data center roof failures differ from roof failures in office buildings, warehouses, or retail facilities because of the operational consequences. When a warehouse roof leaks, the damage might involve wet inventory or temporary operational disruption. When a data center roof leaks, the consequences can cascade into system-wide operational failure.

Water intrusion into electrical infrastructure creates immediate shutdown risks. Moisture in server areas can damage equipment worth tens of millions of dollars. Cooling system disruptions from roof work or roof-related facility shutdowns can cause thermal events that corrupt data or damage processors. Humidity variations affect sensitive electronic equipment even before visible water appears.

Client SLA agreements in colocation facilities often specify uptime guarantees of 99.99% or higher, allowing only 52 minutes of downtime annually. Tier III and IV data centers target 99.982% to 99.995% uptime. Weather-related roof failures that force even brief equipment shutdowns for protective measures violate these agreements and trigger financial penalties that can exceed the cost of roof repairs by factors of 10 or more.

Beyond direct operational and financial consequences, roof failures affect data center reputation and client confidence. Enterprise clients selecting colocation facilities or cloud service providers evaluate infrastructure reliability as a primary decision criterion. Facilities with roof failure histories face client churn and difficulty attracting new business regardless of how quickly repairs were completed.

These consequences make data center roofing a critical infrastructure component rather than a commodity building envelope element. The roof system must be engineered to eliminate weather-related failure possibilities rather than simply meeting minimum building code requirements.

Class 4 Impact-Resistant Membrane Systems

Protecting data center roofs from hail damage starts with selecting membrane systems engineered specifically for impact resistance.

Understanding UL 2218 Impact Resistance Ratings

The UL 2218 standard classifies roofing material impact resistance into four classes based on their ability to withstand steel balls dropped from specified heights. The test simulates hail impact by dropping steel balls of increasing diameter onto membrane samples and evaluating whether the membrane cracks or fails.

Class 1 systems withstand 1.25-inch diameter steel balls dropped from 12 feet. Class 2 systems handle 1.5-inch balls from 15 feet. Class 3 systems survive 1.75-inch balls from 17 feet. Class 4 systems, the highest rating, must withstand 2-inch diameter steel balls dropped from 20 feet without cracking or compromising the waterproofing integrity.

These ratings correlate approximately to hail sizes, though the correlation isn't exact because hail density and trajectory vary with storm conditions. Generally, Class 1 systems provide protection against hail up to about 1 inch diameter. Class 2 handles 1.25-inch hail. Class 3 addresses 1.5-inch hail. Class 4 systems protect against 2-inch and larger hail.

For Texas and Oklahoma data centers, Class 4 impact resistance should be considered the minimum acceptable standard given regional hail frequency and typical hail sizes during severe events. Installing anything less than Class 4 creates known vulnerability to weather events that occur multiple times annually.

Membrane Materials and Construction for Impact Resistance

Achieving Class 4 impact resistance requires specific membrane materials and construction methods. Not all TPO, PVC, or modified bitumen systems qualify as Class 4, manufacturers achieve the rating through reinforced membrane construction.

TPO membranes achieve Class 4 ratings through heavy fiberglass reinforcement, typically 60-mil or thicker overall membrane thickness with high-strength backing materials. The reinforcement distributes impact energy across a wider membrane area, preventing localization that causes cracking. Some manufacturers use fleece-backed TPO where polyester fleece provides additional impact cushioning.

PVC membranes use similar approaches with reinforced construction, typically polyester-reinforced formulations in 60 to 80-mil thicknesses. The plasticizer content in PVC provides inherent flexibility that helps the material absorb impact without cracking, but Class 4 ratings still require reinforced construction rather than homogeneous membranes.

Modified bitumen systems achieve Class 4 ratings through multi-ply construction with granulated cap sheets. The granule surface protects the underlying bitumen from direct hail impact, and the multi-ply construction provides redundant waterproofing layers. If hail damages the cap sheet granules and surface bitumen, lower plies maintain waterproofing integrity.

Facility managers evaluating roofing systems should request specific manufacturer test data showing Class 4 certification for the proposed system. The certification applies to complete roof assemblies, not just membrane products, manufacturers test specific combinations of membrane, insulation, cover boards, and attachment methods. Substituting components or installation methods can void Class 4 certification even when using materials from Class 4-rated systems.

FM Global Approved Assemblies for Insurance Compliance

Many data center insurance policies require roof systems to meet FM Global (Factory Mutual) approval standards in addition to or instead of UL impact ratings. FM Global is an insurance and risk management company that conducts extensive testing of building systems and publishes approved assembly specifications.

FM Global roof assembly approvals address wind uplift resistance, hail resistance, and fire ratings. The testing is more comprehensive than UL 2218 alone, FM evaluates complete roof assemblies under severe weather simulations that include high winds, driving rain, and hail impact in combination rather than testing each factor separately.

Data center operators should verify whether their insurance policies specify FM Global approved assemblies and what specific approval ratings are required. Common requirements include 1-90 severe hail ratings and specific wind uplift classifications based on building height and location exposure.

Achieving FM approvals often requires specific insulation types, cover boards, and membrane attachment patterns that go beyond basic code compliance. Facility managers should work with roofing contractors who have experience with FM Global assembly construction and can provide proper documentation for insurance compliance.

The insurance premium implications are significant. Many insurers offer 10-20% premium reductions for data centers with FM-approved Class 4 roofing systems compared to standard construction. Over a 15-20 year roof service life, these savings can offset much of the premium cost for impact-resistant systems, making Class 4 roofs not just operationally wise but financially justified through insurance considerations alone.

Roof System Upgrades for Existing Data Centers

Many data centers operating in Texas and Oklahoma were constructed before hail resistance became a recognized design priority or were designed by teams from low-hail markets who didn't appreciate regional weather exposure. These facilities now face the question of whether to retrofit impact-resistant systems or accept ongoing hail damage risk.

The decision depends on remaining roof service life, insurance requirements, operational risk tolerance, and financial resources. A roof with 3-5 years of remaining service life that has experienced hail damage might justify early replacement with a Class 4 system rather than temporary repairs followed by later standard replacement. A roof with 10+ years of service life might justify temporary repairs with Class 4 replacement planned at normal service life end.

Some facilities pursue coating-based upgrades where impact-resistant coating systems are applied over existing membranes to improve hail resistance without full tear-off and replacement. This approach works when underlying membrane and insulation are in good condition and the coating system carries Class 4 certification. Silicone coatings in particular can achieve Class 4 ratings when applied at proper thickness over appropriate substrates.

Another approach for facilities unable to fund immediate roof replacement is adding impact protection to the most vulnerable roof areas like equipment zones, penetrations, and drainage paths. Protective screening, impact-resistant walkway pads, or localized membrane upgrades can reduce risk while deferring full roof replacement to future capital cycles.

Regardless of approach, existing data centers should evaluate current roof systems against realistic hail exposure and operational risk. Knowing you have a roof system that will fail during the next major hail event allows proactive planning rather than reactive emergency response.

Redundant Drainage System Design

Impact-resistant membranes prevent hail from puncturing the roof, but severe storms still create drainage challenges that threaten data center operations if not properly addressed.

Why Standard Drainage is Inadequate for Mission-Critical Facilities

Most commercial roofs are designed with minimum code-compliant drainage: primary roof drains sized for local rainfall intensity, sloped to prevent ponding water, and connected to building drainage systems. This approach works for typical buildings where temporary water accumulation during extreme storms is annoying but not operationally critical.

Data centers require higher drainage standards because water accumulation poses unacceptable risks. First, ponding water on a roof increases the likelihood that any hail damage or membrane defect will result in water infiltration. Water seeks the lowest point, and if that point is a hail-impacted membrane area, even minor damage can admit water into the facility.

Second, severe hailstorms produce not just hail but also heavy rainfall and debris. Hail accumulation and tree debris can clog primary roof drains, causing drainage system failure exactly when water removal is most critical. Standard single-path drainage has no failsafe if primary drains become blocked.

Third, the weight of accumulated water stresses roof structures. While code-required structural designs account for water loading, minimizing that load through rapid drainage reduces structural stress and eliminates standing water that could infiltrate through storm-damaged membranes.

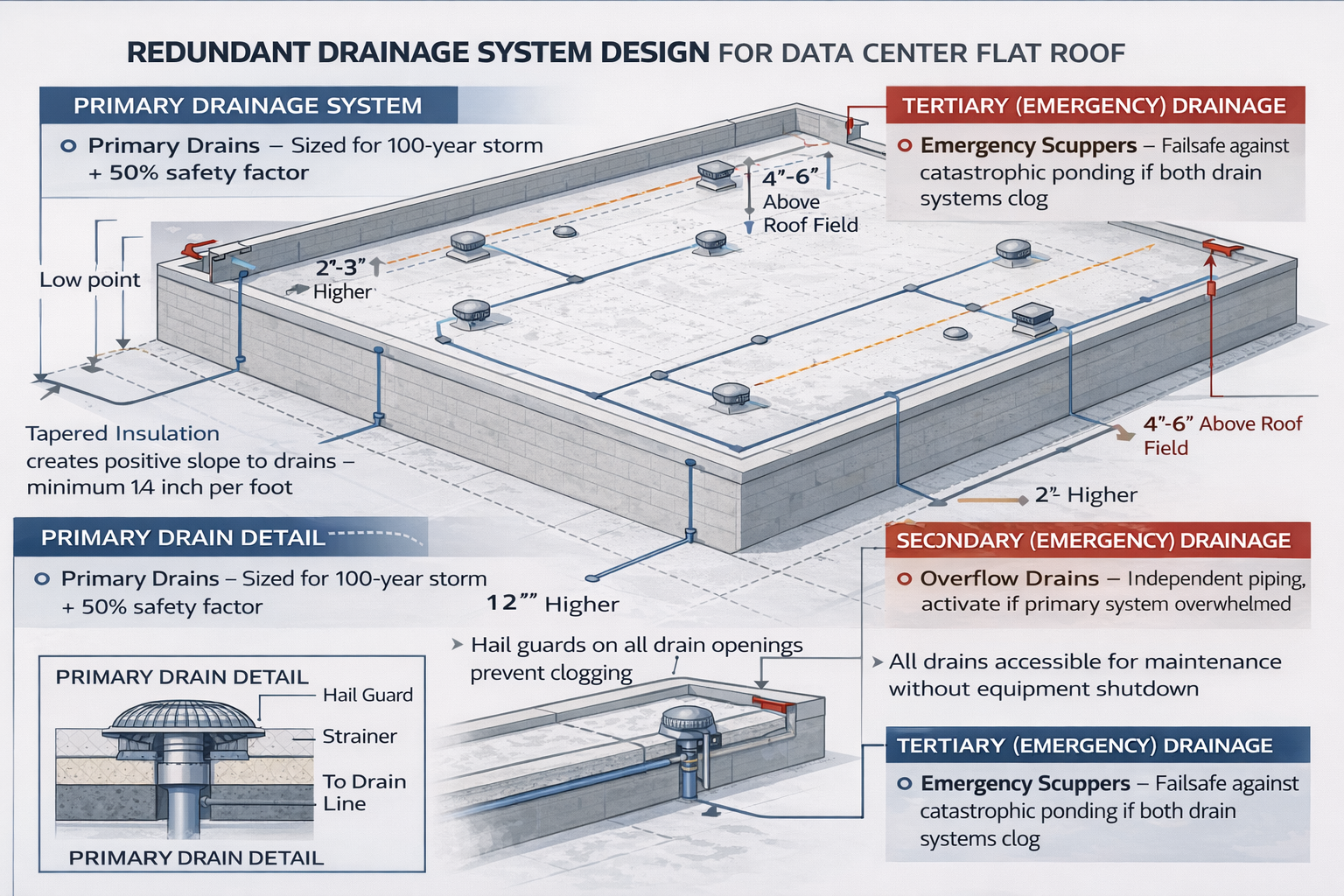

Primary and Secondary Drainage Paths

Redundant drainage systems provide multiple independent paths for water removal so that drainage continues even if one system fails or is overwhelmed. The approach uses three tiers: primary drains, overflow drains, and emergency scuppers.

Primary drains are conventional interior roof drains located at low points in the roof field, sized for 100-year storm rainfall intensity plus 50% additional capacity to account for partial debris blockage. These drains handle normal rainfall and moderate storm events efficiently.

Overflow drains are secondary interior drains located near primary drains but set at elevations 2-3 inches higher than the primary drain inlets. These drains connect to independent drain piping separate from primary drain lines. Overflow drains activate only when water level rises above normal, indicating either extreme rainfall exceeding primary drain capacity or primary drain blockage. By providing a second drainage path through independent piping, overflow drains ensure water removal continues even if primary drains fail.

Emergency scuppers are openings through the roof parapet or wall at elevations 4-6 inches above the main roof field. These function as absolute failsafe drainage, activated only if both primary and overflow drain systems are overwhelmed. Scuppers prevent catastrophic water accumulation by allowing water to discharge over the building edge rather than continuing to load the roof structure. While scupper discharge isn't ideal (water falling from roof edge can damage landscaping or create ground-level flooding), it's far preferable to roof collapse or massive water infiltration through overloaded drainage.

The three-tier approach provides failsafe water removal appropriate to mission-critical facilities. For each tier to fail, separate independent system failures must occur, a highly unlikely scenario even during extreme weather.

Sizing Drainage for Extreme Events

Standard building codes require drainage sizing based on local rainfall intensity data, typically 100-year storm events. For data centers, designing to code minimums creates unnecessary risk because extreme weather events exceed code design criteria with regularity in Texas and Oklahoma.

Conservative data center drainage design uses 100-year storm intensity plus 50-100% safety factor. If code calculations suggest 8 drains based on roof area and rainfall intensity, a data center design might install 12 drains, distributing them to maintain drainage capacity even with several drains blocked by debris.

Drain sizing should also consider debris loading during hail events. Leaves, twigs, and other materials dislodged by hail and wind can block drain inlets rapidly. Using oversized drain domes with large surface areas reduces blockage risk. Hail guards (wire cages or screens) over drain inlets prevent large debris entry while allowing water and small hail through.

Tapered insulation systems that create positive slope toward drains improve drainage effectiveness by ensuring water flows actively toward drains rather than relying solely on drain negative pressure. Minimum slopes of 1/4 inch per foot toward drains are recommended, with steeper slopes (1/2 inch per foot) near drain locations for rapid water removal.

Drainage Maintenance and Emergency Preparedness

Even well-designed drainage systems require regular maintenance to function as intended. Data center facility managers should implement quarterly drain inspections with full cleaning before spring severe weather season.

Inspection protocols should include drain dome and strainer examination for debris accumulation, drain sump cleaning to remove sediment and biological growth, verification that overflow drains and scuppers are clear and unobstructed, and documentation of any drainage impairments or needed repairs.

Emergency preparedness includes pre-staging materials for temporary drainage improvements if storms cause damage or blockage. Temporary sump pumps can be deployed to remove water accumulation if drain systems are overwhelmed. Portable trash pumps can discharge water over roof edge through temporary hoses if interior drains become completely blocked.

Where 24/7 emergency roof repair services with rapid response for storm damage are pre-arranged with contractors, those emergency response plans should include drainage system assessment and temporary drainage installation as immediate post-storm actions.

The goal is ensuring that drainage never becomes the failure point during severe weather. Redundant systems properly maintained eliminate drainage as a vulnerability even when storms exceed design criteria.

Protecting Vulnerable Roof Penetrations and Equipment

Hail-resistant membranes and redundant drainage address the roof field, but roof penetrations and equipment create localized vulnerabilities that require specific protection measures.

Curb-Mounted HVAC Equipment and Cooling Infrastructure

Data centers have extensive roof-mounted mechanical equipment including cooling units, air handling equipment, emergency generators, and associated electrical infrastructure. Each equipment curb creates a roof penetration with flashing details that are vulnerable to hail impact.

Standard equipment curbs use sheet metal caps and membrane flashing. Hail large enough to damage roofing membranes can dent metal curb caps, damage flashing details, and compromise waterproofing at curb perimeters. For critical facilities, these vulnerable points need specific protection.

Impact-resistant curb caps use heavier-gauge metal or add protective panels above standard curb construction to absorb hail impact. Some designs use sacrificial impact layers that can be replaced after major hail events rather than requiring full curb and flashing replacement.

Equipment screening or protective canopies positioned above vulnerable equipment can deflect or absorb hail before it strikes equipment or curbs directly. These protective structures need engineering to ensure they don't create wind uplift problems or structural loading issues, but they can significantly reduce hail damage to equipment and flashing.

Vibration isolation systems common on data center HVAC equipment create another consideration. Roof work for emergency repairs often requires temporary equipment shutdown or vibration control to prevent transmission to sensitive electronic equipment. Equipment protection strategies should minimize the need for emergency roof access near operating equipment.

Pipe Penetrations and Electrical Conduit Entry Points

Smaller roof penetrations for plumbing vents, electrical conduit, and telecommunications cables create localized weak points. Standard pipe boots and pitch pockets seal these penetrations adequately for normal conditions but can be damaged by direct hail impact.

Pipe boot protective covers are simple metal or plastic caps installed over pipe boots to shield them from direct impact. The covers absorb hail energy rather than transmitting it to the boot seal, extending service life and reducing emergency leak repair frequency.

Pitch pockets, a common penetration sealing method for irregular penetrations, are particularly vulnerable because the sealant compounds degrade when struck by hail. Data centers should avoid pitch pockets where possible, using curbed and flashed penetrations instead. Where pitch pockets are unavoidable, protective covers reduce hail exposure.

The concentration of cable and conduit penetrations near main electrical service entry points creates zones of elevated vulnerability. Protective screening or localized membrane reinforcement in these zones reduces failure risk.

Edge Metal and Parapet Cap Vulnerabilities

Roof edge conditions including gravel stops, parapet caps, and coping create waterproofing details that can be damaged by hail and wind-driven rain during severe weather. Parapet caps in particular see direct hail impact on horizontal surfaces.

Heavy-gauge metal edge details provide better hail resistance than minimum code-compliant installations. Using 24-gauge or heavier metal for parapet caps versus standard 26-gauge reduces denting and damage from hail. Continuous cleats and secure fastening prevent edge metal from lifting during high winds, maintaining seal integrity.

The intersection of roof membrane and parapet wall is a critical waterproofing detail. Base flashing must be secured and sealed to prevent water infiltration if parapet caps are damaged. Reinforced membrane at parapet transitions provides redundancy if cap damage allows water behind edge metal.

Some facilities use protective screening along roof edges to reduce hail and wind-driven rain impact on edge details. The screening requires engineering to handle wind loads but can significantly reduce edge damage during severe weather.

Emergency Response Protocols for Data Center Roofing

Even the best-designed roof systems can experience damage during extreme weather. What differentiates resilient data centers from vulnerable facilities is the speed and effectiveness of emergency response when damage occurs.

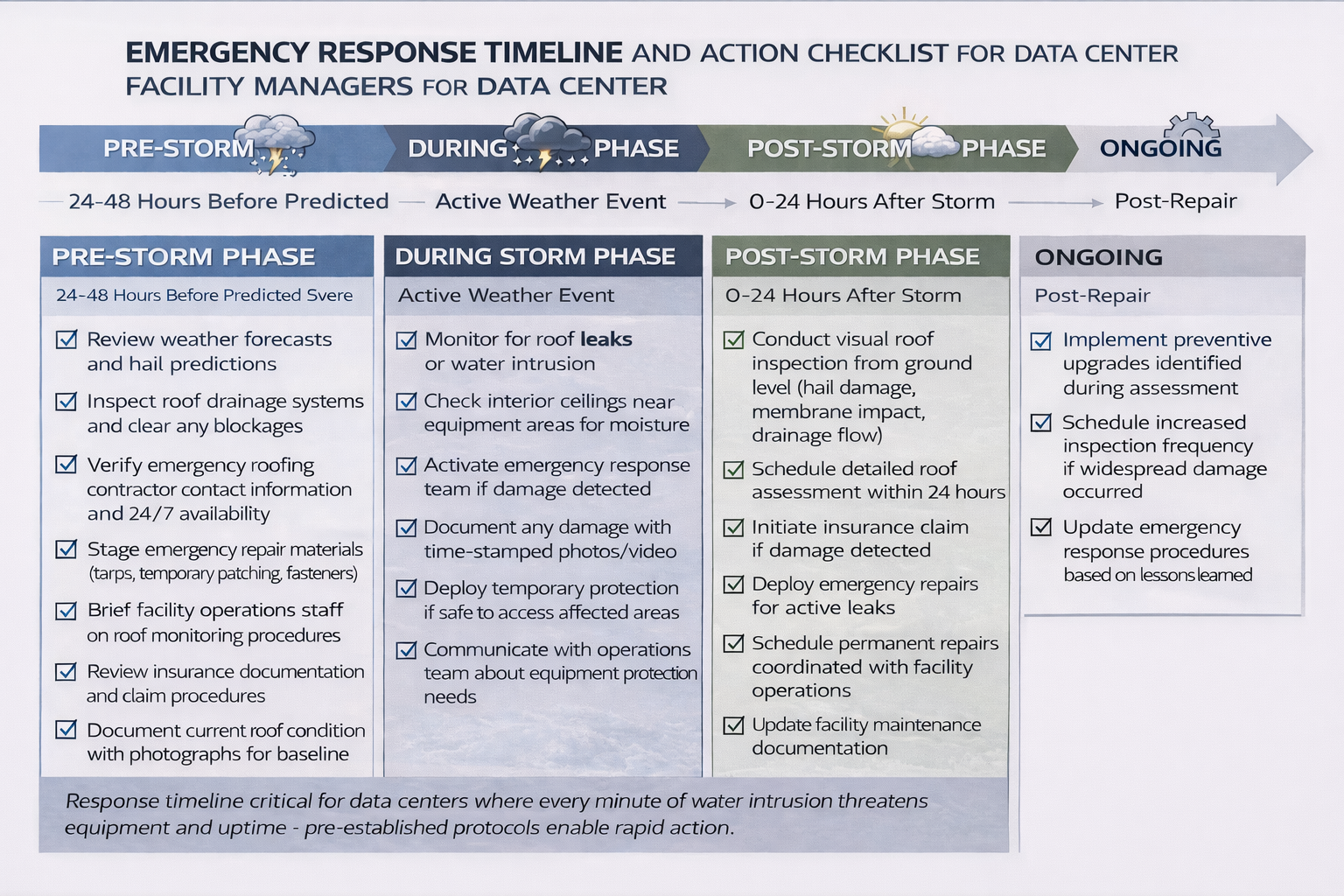

Pre-Storm Preparedness and Planning

Effective emergency response begins before storms occur with pre-established protocols, pre-qualified contractors, and staged materials. Waiting until after roof damage to identify contractors and develop response procedures guarantees delays that extend equipment exposure to weather infiltration.

Data center facility managers should pre-qualify commercial roofing contractors with demonstrated data center experience, understanding of mission-critical facility operational requirements, 24/7 emergency availability with documented response times, and appropriate insurance and safety certifications for data center facility access. These contractors should be under contract or formal service agreement before emergency situations develop.

Emergency response materials should be staged on-site or at contractor facilities for rapid deployment. This includes heavy-duty tarps sized for equipment area coverage, temporary patching materials compatible with the installed roofing system, water extraction equipment including shop vacs and dehumidifiers, moisture detection instruments for identifying hidden water infiltration, and fasteners and installation tools for rapid temporary weatherproofing.

Pre-storm procedures should include weather monitoring with established thresholds for activating response teams, roof drainage verification and clearing before predicted severe weather, briefing facility operations staff on leak detection and emergency notification procedures, and documentation of pre-storm roof conditions for insurance and baseline purposes.

During-Storm Monitoring and Immediate Response

During active severe weather, data center operations staff should implement enhanced monitoring for any signs of roof failure or water intrusion. This includes visual inspection of ceiling areas near critical equipment for moisture or discoloration, monitoring building automation systems for humidity anomalies that might indicate water infiltration, listening for unusual sounds indicating roof damage or excessive water flow, and maintaining communication with pre-qualified roofing contractors who are monitoring storm progress and preparing for potential deployment.

If roof leaks are detected during active weather, immediate actions include notifying facility management and emergency response contractors, deploying temporary water containment (buckets, tarps, plastic sheeting) to protect equipment, activating backup systems or load-shifting protocols if equipment shutdown is necessary for protection, and documenting leak locations and severity with photographs and written descriptions time-stamped for insurance purposes.

The goal during active weather is protecting equipment and maintaining operations while gathering information needed for effective post-storm response. Attempting extensive roof access during severe weather is unsafe and generally ineffective, containment and documentation enable rapid action once conditions allow safe roof access.

Post-Storm Assessment and Temporary Repairs

Within 24 hours of storm passage, comprehensive roof assessment should begin. For data centers, this assessment needs to happen quickly because every hour that damaged roof membranes remain unrepaired increases the risk that additional rainfall will infiltrate through damage points and affect equipment.

The assessment should include visual inspection from ground level using binoculars to identify obvious damage without roof access delay, safe roof access inspection documenting all visible membrane damage, punctures, tears, or impact points, drainage system function verification ensuring drains are clear and flowing properly, and interior investigation checking for any water infiltration that might not be immediately visible from exterior inspection.

Based on assessment findings, emergency repairs should proceed immediately for any active leaks or damage that could allow water infiltration during subsequent rainfall. Temporary repairs are not intended as permanent solutions but as rapid weatherproofing to protect the facility while permanent repairs are scheduled and coordinated with operations.

Temporary repair methods include membrane patching with peel-and-stick patches or heat-welded repairs for small punctures, tarp installation secured with proper fastening for larger damaged areas, water diversion using temporary berms or channels to route water away from damaged areas toward functioning drains, and equipment coverage using tarps or plastic sheeting if roof work might generate debris or moisture near operating equipment.

All temporary repairs should be documented with photographs showing before and after conditions, written descriptions of damage locations and repair methods, and estimated timelines for permanent repairs. This documentation supports insurance claims and provides facility management with accurate information about equipment risk and facility status.

Coordinating Permanent Repairs With Data Center Operations

Permanent roof repairs on data centers require careful coordination with facility operations to minimize disruption and maintain uptime. Unlike warehouse or office building roof repairs that can proceed during business hours with minor inconvenience, data center roof work involves unique challenges.

Vibration from equipment operation, roofing demolition, and material handling must be controlled to prevent transmission to sensitive electronic equipment. Some facilities require roof work scheduling during low-load periods when equipment can be shifted to redundant systems. Hot work (heat welding membranes, torch applications) requires fire watch procedures and coordination with facility fire suppression systems.

Access control and security protocols affect contractor scheduling and work procedures. Many data centers restrict contractor access to specific areas, require escorts, and mandate background checks for workers accessing the facility. These requirements mean repair crews might be smaller than typical commercial roofing projects and scheduling might be constrained to specific time windows.

Documentation requirements are more extensive than typical construction projects. Data centers often require detailed daily reports of work performed, materials used, and any anomalies or concerns that developed during work. Photographic documentation of repairs shows insurance carriers and facility management the scope and quality of restoration work.

The permanent repair scope should address not just immediate damage but also underlying vulnerabilities that contributed to failure. If hail damage revealed that the membrane system lacked adequate impact resistance, permanent repairs should include Class 4 membrane upgrades in damaged areas as down payment on facility-wide upgrades during future re-roofing. If drainage inadequacy contributed to damage severity, drainage improvements should be incorporated into permanent repairs.

Long-Term Roof Asset Management for Data Centers

Protecting data center roofs from hail extends beyond initial system selection and emergency response to comprehensive lifecycle management that maintains protection over decades of facility operation.

Inspection Frequencies and Documentation Standards

Data center roofs warrant more frequent inspection than typical commercial buildings due to the operational consequences of roof failures. Semi-annual inspections should be considered minimum standard, with additional inspections following any severe weather events.

Spring inspections before severe weather season should focus on drainage system function, membrane condition assessment, and equipment penetration integrity. Fall inspections after summer heat stress should evaluate membrane aging, examine areas where thermal cycling might have caused deterioration, and verify readiness for winter weather.

Post-storm inspections after any hail event are essential regardless of whether visible damage is apparent. Hail impact that doesn't immediately puncture membranes can still cause damage that manifests as leaks months later after thermal cycling weakens impact-compromised material. Documenting post-storm conditions provides baseline for evaluating whether future leaks are storm-related or normal wear.

Inspection documentation should include comprehensive photographs cataloging overall roof condition and specific detail conditions, written condition reports describing findings and recommendations, drone imagery for large facilities providing aerial documentation of entire roof areas, and thermal imaging where moisture intrusion concerns exist to identify wet insulation or hidden leaks.

This documentation serves multiple purposes: tracking roof condition changes over time to predict maintenance needs, supporting insurance claims if storm damage causes failures, demonstrating proactive maintenance for warranty compliance, and providing facility management with objective roof condition assessment for capital planning.

Integrating Roof Maintenance Into Facility Operations

Where preventive roof maintenance programs that protect data center uptime are implemented, the maintenance becomes integrated component of facility operations rather than separate construction activity.

Quarterly maintenance activities should include drainage cleaning and verification, minor repairs before small issues become major problems, sealant and flashing inspection with resealing as needed, and debris removal particularly after weather events or nearby construction.

Annual preventive maintenance might include membrane cleaning to maintain reflectivity and energy performance, coating applications to extend membrane service life, equipment curb and penetration resealing, and comprehensive condition assessment with multi-year planning.

The facility management team should track roof maintenance in building management systems alongside mechanical and electrical equipment maintenance. Scheduling automated reminders ensures maintenance happens on schedule rather than being deferred until problems develop.

Planning for System Replacement and Technology Upgrades

Even well-maintained roofs eventually require replacement. Data center operators should plan roof replacement as capital expense timed to minimize operational disruption while incorporating latest protective technologies.

Facility managers should begin replacement planning when roofs reach 60-70% of expected service life. This provides time to budget replacement costs, evaluate new roofing technologies that might offer improvements over current systems, and schedule replacement work during optimal timing windows for data center operations.

Technology improvements in roofing materials mean that replacement projects often provide opportunities for significant upgrades over original construction. Facilities built with Class 1 or 2 systems can upgrade to Class 4 impact resistance. Buildings with minimal drainage can incorporate redundant systems. Older facilities with inadequate insulation can achieve current energy efficiency standards.

Replacement planning should coordinate with other facility system upgrades. If HVAC equipment is nearing replacement timing, coordinating roof and equipment replacement allows integrated design and consolidated disruption rather than separate projects affecting operations multiple times.

For facilities where data center roofing services specialized for mission-critical facilities are engaged during planning phases, replacement projects can incorporate lessons learned from the existing roof's performance and address operational challenges that original construction didn't anticipate.

Conclusion

Data centers in Texas and Oklahoma operate in one of the most hail-prone regions in North America while housing infrastructure that cannot tolerate weather-related failures. Standard commercial roofing approaches adequate for typical buildings create unacceptable vulnerabilities when applied to mission-critical facilities where uptime requirements, equipment values, and client obligations make roof failures operationally catastrophic.

Protecting data center roofs from Texas hailstorms requires Class 4 impact-resistant membrane systems engineered specifically to withstand 2-inch and larger hail, redundant drainage systems providing failsafe water removal even when primary systems are overwhelmed or blocked, protection for vulnerable penetrations and equipment where standard flashing details create localized weak points, and pre-established emergency response protocols enabling rapid assessment and temporary weatherproofing when storm damage occurs.

The initial cost premium for impact-resistant systems and redundant infrastructure is significant compared to minimum code-compliant construction, but the premium is modest compared to the costs of operational disruption, equipment damage, client SLA penalties, and facility reputation impact that roof failures generate. Insurance premium reductions for Class 4 and FM-approved systems offset much of the cost difference over typical roof service life, making protective systems financially rational beyond just operational necessity.

Existing data centers designed before hail resistance became recognized priority face decisions about retrofit timing and scope. Evaluating current roof systems against realistic severe weather exposure helps facility managers assess risk and plan upgrades that improve protection before the next major hail event exposes vulnerabilities.

For new construction and major renovations, incorporating hail protection into initial design is far more cost-effective than retrofitting after facility completion. Working with design teams who understand Texas and Oklahoma weather exposure ensures specifications appropriate to regional conditions rather than generic approaches imported from low-hail markets.

Long-term protection requires ongoing commitment to inspection, maintenance, and documentation that maintains roof system performance throughout facility operational life. Data centers that integrate roof maintenance into comprehensive facility management achieve better outcomes than facilities that neglect roofs until failures force emergency attention.

To discuss hail protection systems for your Texas or Oklahoma data center, call TriVAN Roofing at 877-487-4826. We specialize in mission-critical facility roofing with extensive experience in data center construction, retrofit projects, and emergency response for facilities where roof performance directly impacts operational uptime and client service delivery.

Tags: data center roofing Texas, hail damage prevention commercial roof, impact resistant data center roof, Class 4 roofing systems, mission critical facility roofing, center hail protection, Texas hailstorm roof damage, redundant roof drainage, data center emergency roof repair, Oklahoma data center roofing
