Commercial Rooftop Solar and Your Roof: What Facility Managers Need to Know Before Signing the Contract

| By TriVAN Roofing | 18 min read

Commercial Rooftop Solar and Your Roof: What Facility Managers Need to Know Before Signing the Contract

Texas solar boom creates rooftop challenges for facility managers as 25-30 year solar contracts conflict with 15-20 year roof lifespans, potentially requiring costly mid-contract panel removal and warranty voids.

The Texas Commercial Solar Boom Creates Hidden Rooftop Challenges

Texas leads the country in commercial solar installation, with the state installing 25% of all new solar capacity in the United States and driving unprecedented growth across the commercial building sector. Commercial solar installation growth in 2024 was driven by smaller markets like Texas, Ohio, and Pennsylvania contributing to record segment growth , fueled by aggressive energy costs, federal tax incentives, and the state's business-friendly solar policies.

This rapid expansion has created a wave of solar leasing companies and Power Purchase Agreement (PPA) providers actively selling to commercial building owners across Texas and Oklahoma. These contracts typically span 20-25 years, creating long-term commitments that facility managers often sign without fully understanding how they interact with roof systems that may only have 5-15 years of remaining useful life.

For facility managers evaluating solar proposals, the solar sales pitch focuses heavily on energy savings and federal tax benefits while glossing over critical rooftop implications. The reality is more complex: solar panels are designed to last 25 years or more, which means the roof beneath them should have a comparable lifespan , yet most commercial buildings considering solar installation have existing roof membranes with significantly shorter remaining lifespans.

Understanding these rooftop implications before signing any solar contract can save facility managers tens of thousands of dollars in unexpected costs and protect valuable roof warranty coverage that might otherwise be voided by solar installation.

The Fundamental Conflict Solar Installers Don't Discuss

The solar industry promotes a compelling value proposition: clean energy, reduced utility costs, and attractive federal tax incentives. However, there's a fundamental timing conflict that most solar companies conveniently omit from their financial projections.

Infographic showing timeline conflict between solar panel and roof membrane lifespans with cost warnings
The lifespan mismatch between solar panels (25-30 years) and commercial roof membranes (15-20 years) creates an inevitable conflict that most solar financial projections ignore. Panel removal and reinstallation costs typically range from $8-15 per square foot, meaning a 5,000 square foot solar array could require $40,000-75,000 in unplanned expenses during the solar contract term for roof replacement projects.

Solar panels have a lifespan of about 25 to 30 years , with many continuing to produce electricity well beyond their warranty period. In contrast, commercial roof membranes like TPO typically last 20 to 30 years with proper maintenance , while EPDM roofs have a lifespan of 15 to 20 years , and many existing commercial roofs are already 8-15 years into their lifecycle when solar installation is considered.

This creates an inevitable conflict: most buildings installing solar today will need to remove and reinstall panels for roof replacement during the solar contract term. The cost to remove solar panels for a roof replacement is $200 to $300 per panel , with total removal and reinstallation costs ranging from $2,800 to $4,800 for typical residential systems.

For commercial installations, these costs scale significantly. A 5,000 square foot solar array typically contains 150-200 panels, creating removal and reinstallation costs of $40,000-75,000 that are almost never included in solar financial projections. This expense can completely undermine the projected return on investment that justified the solar installation in the first place.

Real-World Cost Impact

Consider a typical scenario: an office building signs a 25-year PPA with a solar company, installing a ballasted system on a 12-year-old TPO membrane roofing system. The solar financial analysis projected $2.1 million in energy savings over the contract term.

However, at year 15 of the solar contract, the TPO roof reaches the end of its useful life and requires replacement. The building owner discovers:

  • Panel removal costs: $52,000
  • Roof replacement: $280,000
  • Panel reinstallation: $55,000
  • Total unplanned capital cost: $387,000

This $387,000 expense represents 18% of the projected solar savings and was never included in the original financial analysis. Worse, if the building owner cannot afford these costs immediately, they may face contract penalties for lost energy production during extended roof replacement periods.

Roof Penetration Warranty Issues That Catch Building Owners Off Guard

Beyond the cost implications, solar installation creates warranty conflicts that many facility managers discover only when they need to file a claim. The warranty typically remains valid for the original roofing materials but may not cover areas where penetrations were made for solar mounting .

Commercial roof warranty documents and solar contracts on desk with magnifying glass highlighting warranty terms
Commercial roof warranties often contain specific clauses that void coverage when unauthorized penetrations are made by non-certified contractors. Solar installers are rarely certified by roofing manufacturers, creating a warranty conflict that may not become apparent until a leak develops and the manufacturer denies the claim. Facility managers should review warranty terms carefully and require manufacturer coordination before any solar installation begins.

Most commercial roofing manufacturers void No Dollar Limit warranty coverage when penetrations are made by non-certified contractors. The challenge: solar installers are almost never certified by roofing manufacturers like Duro-Last, GAF, or Carlisle, which means solar installation can immediately void existing manufacturer warranty coverage that may have 8-12 years of valuable protection remaining.

Adding additional penetrations and equipment to your roof can void your warranty when the proper steps and contractors are not consulted . The roof warranty exclusion may not become apparent until a leak develops and the manufacturer denies the claim, citing unauthorized penetrations.

The Hidden Warranty Void Process

Here's how warranty voiding typically occurs:

Step 1: Solar Installation Proceeds
The solar company installs mounting systems and runs conduit without consulting the roof manufacturer or using certified commercial roofing contractors.

Step 2: Warranty Coverage Becomes Void
Most roofing manufacturer warranties include specific language that the warranty may be void if the roof is "altered or penetrated by a third party" without using manufacturer-approved methods .

Step 3: Leak Develops
A roof leak occurs in year 3-5 of the solar installation, potentially related to thermal movement around penetrations or flashing failure.

Step 4: Warranty Claim Denied
The manufacturer inspects the roof, discovers unauthorized penetrations from the solar installation, and denies warranty coverage, leaving the building owner responsible for all repair costs.

This scenario is particularly problematic for facilities with premium warranty coverage. TriVAN Roofing's 15-year transferable No Dollar Limit warranties, for example, provide exceptional protection against consequential damages and ponding water issues, but this valuable coverage can be immediately compromised by unauthorized solar penetrations.

Ballasted Versus Penetrating Solar Mounting Systems

Solar installers typically offer two mounting approaches for commercial flat roofs, each with significant implications for building structure and roof warranties.

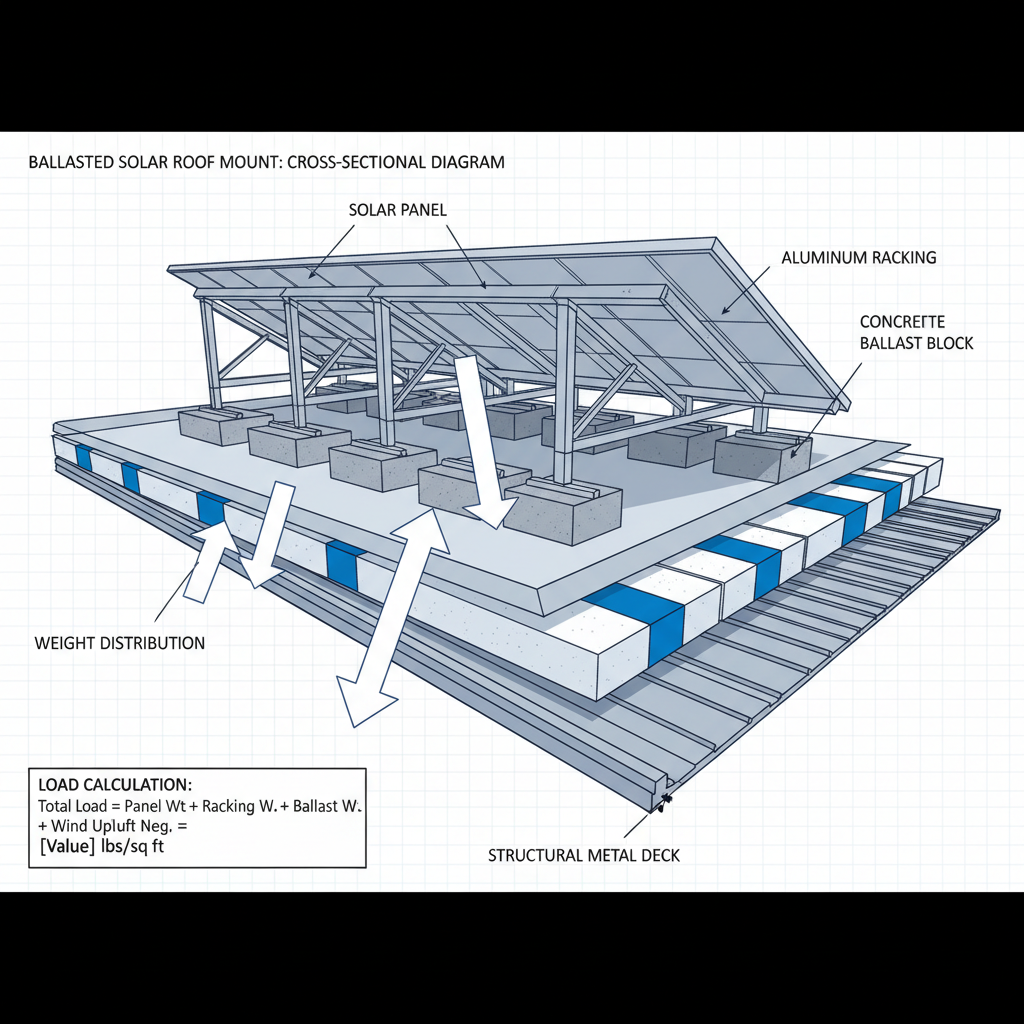

Technical diagram of ballasted solar mounting system showing weight distribution and structural loads
Ballasted solar systems eliminate roof penetrations but add significant structural load to commercial buildings. A typical 5,000 square foot solar array using ballasted mounting can add 15,000-25,000 pounds of weight to the roof structure, requiring careful structural engineering analysis to ensure the building can safely support the additional load without compromising structural integrity.

Ballasted Systems: Weight Without Penetrations

Ballasted systems use weighted racking to hold panels without roof penetrations, seemingly eliminating warranty concerns. However, these systems create substantial structural challenges. Ballasted systems on flat roofs can weigh 4 to 6 pounds per square foot in total , with some installations requiring even more ballast in high-wind areas.

For a 5,000 square foot solar array, ballasted mounting adds 15,000-25,000 pounds to the roof structure. When you add the aluminum racking, clamps, and concrete ballast required to keep panels in place, the total system weight often exceeds 25 kg/m² (approximately 5.1 pounds per square foot) .

This additional load requires structural load assessments to verify that the deck and supporting structure can handle the weight. Commercial roofs typically range from 40 to 60+ PSF total capacity , but available capacity depends on existing dead loads and code-required live load reserves.

Penetrating Systems: Fewer Attachments, Warranty Coordination Required

Penetrating systems use fewer penetrations with proper flashing details and can maintain warranties if installed by manufacturer-certified contractors. These systems typically add only 2-4 pounds per square foot to the roof structure, well within most buildings' available capacity.

The key advantage: significantly reduced structural impact. The critical requirement: careful coordination between roofing and solar contractors to ensure proper flashing installation and warranty compliance.

Any roof penetrations or anchors must be installed or flashed according to your roof manufacturer's specifications, with penetrations or anchors for solar racking accessible for final manufacturer inspection .

Making the Right Choice

The mounting system decision should be based on:

  • Structural Capacity: Buildings with limited structural capacity may require penetrating systems to avoid overloading the roof structure
  • Warranty Requirements: Maintaining manufacturer warranty coverage requires careful coordination regardless of mounting method
  • Wind Exposure: High-wind areas may require additional ballast, further increasing structural loads
  • Future Access: Consider maintenance access requirements for both roof and solar system components

Structural Load Assessment Requirements

Every commercial solar installation requires careful evaluation of the building's structural capacity to safely support additional loads. This assessment becomes critical when considering the multiple load factors that solar installation introduces.

Solar System Weight Components

Standard commercial solar panel systems weigh approximately 2 to 4 pounds per square foot when including mounting hardware, with panels themselves typically weighing 35 to 50 pounds each . However, the mounting method significantly affects total system weight.

For ballasted systems, additional considerations include:

  • Ballast blocks: 5-15 additional pounds per square foot depending on wind requirements
  • Racking systems: Aluminum rails and connection hardware
  • Protection layers: Roof membrane protection materials

For instance, with a wind speed of 150 kilometers per hour and a roof angle of 15 degrees, the minimum ballast weight needed is approximately 85 kilograms per square meter (about 17.4 pounds per square foot).

Wind Load Considerations in Texas Markets

Texas commercial buildings face significant wind design requirements that affect solar installation:

DFW Metroplex: Wind speeds of 90-110 mph design requirements increase ballast needs and structural loading calculations.

Coastal Areas: Hurricane-force wind considerations require additional ballast and more robust structural analysis.

North Texas and Oklahoma: Snow load considerations, while less frequent, must be factored into structural capacity calculations.

When Structural Reinforcement Becomes Necessary

Most lightweight industrial roofs are engineered with a safety margin of only 10–15 kg/m² for additional equipment (approximately 2-3 pounds per square foot). Many commercial buildings have marginal structural capacity that cannot accommodate solar loads without reinforcement.

Structural reinforcement costs can range from $3-8 per square foot, adding $15,000-40,000 to a typical commercial solar project. These costs are often discovered during the permitting process, after contracts have been signed and financial projections completed.

A structural engineer typically charges $500 to $2,000 for a roof load assessment, which includes reviewing the original building plans, inspecting the roof truss or rafter system, and providing a written report confirming the roof's actual capacity . This small investment can prevent much larger expenses and project delays.

Strategic Roof Replacement Timing Before Solar Installation

The most effective strategy for avoiding mid-contract panel removal costs is coordinating roof replacement with solar installation timing. Buildings with roofs more than 8-10 years old should seriously consider commercial roof replacement projects before committing to 20-25 year solar contracts.

The Financial Logic

While replacing a roof before solar installation adds upfront cost, it eliminates the much larger future expense of panel removal and reinstallation. Consider the financial comparison:

Scenario A: Install Solar on Existing Roof

  • Solar installation: $150,000
  • Roof replacement at year 12: $75,000
  • Panel removal and reinstallation: $45,000
  • Total cost: $270,000

Scenario B: Replace Roof First, Then Install Solar

  • Roof replacement: $75,000
  • Solar installation with coordinated design: $155,000
  • Total cost: $230,000
  • Savings: $40,000

Beyond cost savings, replacing the roof first provides several strategic advantages:

Coordinated Installation Benefits

Integrated Design: Solar mounting can be built into the roof design from the beginning, ensuring optimal waterproofing and structural integration.

Single Project Management: Coordinating roof and solar installation under unified project management reduces scheduling conflicts and weather delays.

Warranty Alignment: Both roof and solar warranties begin simultaneously, eliminating coverage gaps and simplifying future maintenance coordination.

Optimal Mounting Location: New roof installation allows for precise placement of structural reinforcement and mounting points where needed.

Roof Assessment Before Solar Commitment

Before signing any solar contract, facility managers should commission an independent roof assessment that evaluates:

  • Remaining useful life: Professional assessment of current membrane condition and expected remaining lifespan
  • Structural capacity: Engineering analysis of available load capacity for solar installation
  • Warranty status: Review of existing warranty coverage and requirements for maintaining protection
  • Drainage adequacy: Evaluation of roof drainage systems that may be impacted by solar installation

This assessment typically costs $1,500-3,500 but can save tens of thousands in avoided problems and optimized installation timing.

Warranty Coordination When Solar Installation is Inevitable

When roof replacement timing doesn't align with solar installation schedules, careful warranty coordination becomes essential to maintain manufacturer coverage.

Pre-Installation Manufacturer Involvement

The roof manufacturer must be involved before solar installation begins. Let your roof warranty company know that you're putting solar on and have them come out to pre-inspect the new roof, making sure all paperwork is filled out and turned in with necessary information on the panels you are installing .

This pre-installation process typically includes:

Formal Notification: Written notification to the manufacturer describing the planned solar installation, including mounting method, panel specifications, and installation timeline.

Installation Plan Review: Manufacturer review of penetration locations, flashing details, and installation sequence to ensure warranty compliance.

Certified Contractor Requirement: Solar installer must work under the direction of a certified roofing contractor for any penetrations and flashing work.

Required Installation Sequences

Maintaining warranty coverage requires specific installation sequences that many solar contractors are unfamiliar with:

Step 1: Roof Preparation
Certified commercial roofing contractors must prepare penetration locations according to manufacturer specifications.

Step 2: Coordinated Penetration
Solar mounting penetrations must be completed using manufacturer-approved flashing details and sealants.

Step 3: Manufacturer Inspection
Penetrations or anchors for solar racking must be accessible for final manufacturer inspection before solar panel installation proceeds.

Step 4: Final Documentation
Notify your warranty company that solar installation is complete. They will come out to re-inspect and make note of any repairs that must be made to continue warranty coverage .

Cost of Warranty Coordination

Proper warranty coordination typically adds $2,000-5,000 to solar installation costs, but this investment protects warranty coverage worth potentially $50,000-150,000 in future protection. The coordination process usually extends installation timelines by 1-2 weeks but prevents warranty voidance that could prove much more costly.

Insurance Considerations for Solar-Equipped Buildings

Commercial insurance carriers are increasingly scrutinizing rooftop solar installations, with some questioning how solar equipment affects fire suppression access, structural integrity, and storm damage risk.

Premium Impact and Coverage Changes

Some commercial carriers are increasing premiums for solar-equipped buildings due to:

  • Fire Risk Concerns: Solar panels can complicate firefighting access and create electrical hazards during emergency situations
  • Wind Uplift Risk: Solar installations create additional wind uplift forces during severe storms, requiring engineering analysis to confirm adequate attachment
  • Maintenance Access: Insurance inspectors may require specific access protocols for both roof and solar system maintenance

Complex Damage Claims

Insurance claims for solar-related roof damage can be complicated by multiple contractor and manufacturer relationships. When storm damage affects both roofing and solar systems, determining responsibility and coverage can involve:

  • Roofing manufacturer warranties
  • Solar equipment warranties
  • Installation contractor warranties
  • Property insurance coverage
  • Solar equipment insurance

These overlapping relationships can delay claim resolution and create coverage gaps that leave building owners responsible for repair costs. Some carriers now require specific documentation of warranty coordination and certified installation to maintain full coverage.

Facility managers should notify their insurance carrier before solar installation and confirm that coverage will remain in effect. Some policies may require riders or modifications to maintain full protection for both roof and solar systems.

Power Purchase Agreements and Solar Lease Contract Implications

The contract terms governing Power Purchase Agreements (PPAs) and solar leases contain provisions that significantly affect building owners during roof replacement scenarios, but these terms are often buried in lengthy contracts that facility managers sign without understanding the long-term implications.

Roof Replacement Provisions in Solar Contracts

Most 20-25 year PPA commitments include specific provisions for roof replacement that building owners need to understand before signing:

Energy Production Loss Payments: Some agreements require building owners to pay the solar company for energy output lost during roof replacement, often calculated at $15,000-40,000 depending on system size and contract terms.

Panel Removal Responsibility: Many contracts require building owners to pay the full cost of panel removal and reinstallation, with no cap on expenses.

Extended Timeline Penalties: Contracts may include penalties for roof replacement projects that extend beyond specified timeframes, typically 30-60 days.

Performance Guarantee Impacts: Roof replacement downtime may affect long-term performance guarantees and payment calculations.

Contract Language to Watch For

Facility managers should carefully review these specific contract provisions:

"In the event that Facility requires roof maintenance or replacement that necessitates temporary removal of the Solar System, Facility shall be responsible for all costs associated with disconnection, removal, storage, and reinstallation of equipment, as well as compensation to Provider for lost energy production during the maintenance period."

This language can create liability for $40,000-80,000 in unexpected costs during a 25-year contract term.

Negotiating Better Terms

Before signing solar contracts, facility managers should negotiate modifications such as:

  • Removal Cost Caps: Limiting building owner responsibility for panel removal costs to specific dollar amounts
  • Shared Responsibility: Splitting removal costs between building owner and solar provider
  • Timeline Extensions: Allowing reasonable timeframes for roof replacement without penalties
  • Warranty Coordination: Requiring solar provider to coordinate with roof manufacturer to maintain warranty coverage

Owned Versus Leased Equipment Impact on Property Transactions

The ownership structure of solar equipment significantly affects commercial property transactions, creating complexities that can impact property values and sale timelines.

Owned Solar Systems

Buildings with owned solar systems transfer equipment ownership as part of the property sale. This typically:

  • Increases Property Value: Owned systems generally add property value roughly equivalent to the remaining system value
  • Simplifies Transactions: No contract assignments or third-party approvals required
  • Transfers Warranties: Equipment and installation warranties typically transfer with property ownership

Leased Systems and PPAs

Buildings with leased systems or PPAs create more complex transaction scenarios:

Contract Transfer Requirements: Buyers must assume existing contract obligations, including all payment terms and maintenance responsibilities.

Credit Qualification: Solar leasing companies may require buyer credit qualification before approving contract transfers.

Early Termination Costs: Some PPAs have early termination fees of $50,000-150,000 that significantly affect property transaction economics.

Financing Complications: Some commercial lenders are reluctant to finance properties with long-term solar lease obligations.

Due Diligence Requirements

Property buyers should carefully evaluate:

  • Remaining contract term and payment obligations
  • Performance guarantees and actual system performance
  • Roof condition and warranty status
  • Insurance requirements and premium impacts
  • Maintenance responsibilities and costs

Properties with solar leases may require 30-60 additional days for transaction completion due to contract transfer requirements and third-party approvals.

Preventive Strategies for Facility Managers

Successful solar installation requires proactive planning that addresses rooftop implications before contracts are signed. Here are the essential strategies for protecting both energy goals and roofing investments:

Pre-Contract Roof Assessment Protocol

Before evaluating any solar proposals, commission a comprehensive roof assessment that includes:

Structural Analysis: Professional engineering evaluation of available structural capacity for different mounting systems.

Membrane Condition Assessment: Detailed evaluation of current roof condition and realistic remaining lifespan projections.

Warranty Review: Complete analysis of existing warranty coverage, requirements, and potential solar installation impacts.

Drainage Evaluation: Assessment of current drainage systems and potential impacts from solar installation.

This assessment typically costs $2,500-5,000 but provides essential information for making informed decisions about solar timing and installation methods.

Solar Proposal Evaluation Criteria

When reviewing solar proposals, facility managers should require:

  • Complete Cost Analysis: Financial projections that include potential roof replacement costs during the contract term
  • Warranty Coordination Plan: Detailed plan for maintaining roof manufacturer warranty coverage
  • Structural Engineering: Professional structural analysis confirming building capacity for proposed mounting systems
  • Insurance Impact Assessment: Analysis of potential insurance premium changes and coverage impacts

Contract Negotiation Priorities

Essential contract modifications to protect building owners:

Removal Cost Limitations: Cap building owner responsibility for panel removal costs at specific amounts or percentages.

Warranty Protection Requirements: Require solar installer coordination with roof manufacturer to maintain existing warranty coverage.

Performance Timeline Extensions: Allow reasonable timeframes for roof maintenance without contract penalties.

Insurance Coordination: Require solar provider to coordinate with property insurance and accept responsibility for premium increases related to solar installation.

Ongoing Maintenance Coordination

After solar installation, establish coordinated preventive maintenance programs that address both roof and solar system needs:

  • Joint Inspections: Coordinate roof and solar system inspections to identify issues affecting both systems
  • Drainage Monitoring: Regular assessment of roof drainage systems that may be impacted by solar equipment
  • Warranty Compliance: Ensure maintenance activities comply with both roof and solar warranty requirements
  • Documentation: Maintain detailed records of all maintenance activities for warranty and insurance purposes

When to Call for Professional Help

Solar installation decisions are too important and too expensive to make without professional guidance. Facility managers should seek expert advice when:

Immediate Professional Consultation Required

  • Solar Proposals Under Review: Before signing any solar contracts or agreements
  • Roof Age Concerns: Buildings with roofs more than 8-10 years old considering solar installation
  • Structural Uncertainty: Any questions about building capacity to support additional solar loads
  • Warranty Questions: Uncertainty about how solar installation affects existing roof warranty coverage
  • Insurance Changes: Notification from insurance carriers about coverage modifications related to solar installation

Emergency Situations

Some situations require immediate professional intervention:

  • Post-Installation Leaks: Any roof leaks that develop after solar installation
  • Warranty Claim Denials: Manufacturer warranty claims denied due to unauthorized modifications
  • Storm Damage: Severe weather damage affecting both roof and solar systems
  • Structural Issues: Any signs of structural stress or damage related to solar system weight

These situations often require emergency roof repairs and coordinated response from both roofing and solar professionals.

Long-Term Planning Support

Professional guidance helps optimize long-term facility management:

  • Capital Planning: Integrating roof and solar replacement cycles into facility capital planning
  • Technology Updates: Planning for solar system upgrades and roof replacement coordination
  • Performance Optimization: Ongoing optimization of both roof and solar system performance
  • Contract Management: Managing complex relationships between roof warranties, solar contracts, and insurance coverage

Protecting Your Facility's Future

The commercial solar boom in Texas presents genuine opportunities for energy cost reduction and environmental benefits. However, the long-term success of these installations depends on careful coordination with existing roof systems and strategic timing that protects both investments.

Facility managers who understand the interactions between 25-30 year solar contracts and 15-20 year roof lifespans can make informed decisions that maximize benefits while minimizing unexpected costs. The key is addressing these rooftop implications before signing contracts, not after problems develop.

The $40,000-75,000 in potential panel removal costs during roof replacement represents just one aspect of the coordination required. Warranty protection, structural capacity, insurance implications, and contract terms all require careful evaluation by qualified professionals who understand both roofing and solar technologies.

Success requires a comprehensive approach that evaluates roof condition, structural capacity, warranty implications, and contract terms together. Facility managers who invest in professional assessment and coordinated planning will realize the full benefits of solar installation while protecting their rooftop investments for decades to come.

The Texas solar market will continue growing, driven by favorable economics and supportive policies. Facility managers who understand and address rooftop implications will be positioned to take advantage of these opportunities while avoiding the costly surprises that catch unprepared building owners off guard.

Tags: commercial rooftop solar, solar panels roof warranty, facility managers Texas, commercial solar contracts, roof replacement solar panels, TPO roof solar installation, ballasted solar systems, commercial roof warranty void, solar PPA contracts, Texas commercial solar
