Building a Commercial Roof Emergency Response Plan: What Texas and Oklahoma Facility Managers Need Before the

| By TriVAN Roofing | 22 min read

Building a Commercial Roof Emergency Response Plan: What Texas and Oklahoma Facility Managers Need Before the

Severe weather doesn't wait for business hours. Texas and Oklahoma facility managers need emergency roof response plans covering pre-storm prep, contractor vetting, insurance timelines, and damage documentation before the next storm hits.

Categories: Weather & Climate

When your phone rings at 2:30 AM and it's security calling about water pouring through the ceiling in the warehouse, you need a plan already in place. Not a vague idea of who might be able to help, not a list of contractors you've been meaning to research, but an actual documented response plan with contact numbers, decision protocols, and pre-vetted resources you can activate immediately.

Facility managers in Texas and Oklahoma deal with this scenario more often than they'd like. The DFW area averages 9-12 hail events per year. Oklahoma City sits in the heart of Tornado Alley and sees severe thunderstorms from March through October. Tulsa faces similar weather patterns with the added challenge of ice storms in winter. Severe weather isn't a possibility in this region, it's a recurring operational reality that requires the same level of planning you'd give to any other business continuity risk.

The difference between a roof emergency that costs $15,000 in temporary repairs and cleanup versus one that costs $150,000 in interior damage, lost inventory, and business disruption usually comes down to response time and decision quality in the first few hours. When you're making critical decisions at 3 AM with water actively leaking onto equipment or product, having predetermined protocols eliminates the confusion that turns containable problems into catastrophic ones.

This guide walks through building a commercial roof emergency response plan specific to your facility, covering what needs to happen before storm season starts, what to do during active weather events, how to respond immediately when damage occurs, and how to avoid the predatory contractors who appear after every major storm event in Texas and Oklahoma.

Why Generic Emergency Plans Don't Work for Roof Damage

Most facility emergency plans cover fire, medical emergencies, and maybe severe weather shelter protocols. They rarely address roof damage response with the specificity needed to actually execute an effective response when it happens.

The problem is that roof emergencies have unique characteristics that generic emergency planning doesn't account for. You're often dealing with damage that's inaccessible during the actual storm. You can't safely get on the roof to assess what's happening when winds are still gusting and lightning is striking. By the time it's safe to investigate the source of the problem, water has already been intruding for hours.

Roof emergencies also require specialized contractors who are available 24/7 and who have the equipment and expertise to provide temporary protection quickly. Your regular HVAC or electrical service contractors can't help you. Finding qualified roofing contractors during or immediately after a major storm event is difficult because every facility in a 50-mile radius is calling the same limited pool of contractors at the same time.

Insurance requirements add another layer of complexity. Most commercial property insurance policies have specific notification timeframes and documentation requirements that facility managers don't know about until they're trying to file a claim. Missing those requirements can complicate or even jeopardize your claim, leaving you paying out of pocket for damage that should have been covered.

A facility-specific roof emergency response plan addresses all of these issues before the emergency happens. You've already identified your vulnerabilities, you've already vetted and established relationships with emergency contractors, you already know what your insurance requires, and you have documented protocols that anyone on your team can follow even if you're not available when the damage occurs.

Pre-Storm Preparation: Building Your Plan Before You Need It

The foundation of effective emergency response is preparation done during calm weather when you have time to think clearly and make good decisions.

Conduct a Vulnerability Assessment

Schedule a professional roof inspection specifically focused on identifying vulnerabilities that could become problems during severe weather. This is different from a standard maintenance inspection. You're looking for things like loose membrane edges that could catch wind, clogged drains that could cause ponding during heavy rain, rooftop equipment that isn't properly secured, and any existing damage that severe weather could make worse.

Document the current condition with photos and written notes. This documentation serves two purposes. First, it gives you a baseline so you can clearly identify what damage is new when you need to file an insurance claim. Second, it helps you prioritize preventive repairs that could prevent emergency situations.

Many facility managers discover during this process that they have existing problems they didn't know about. A small puncture that's been slowly leaking during normal rain becomes a major water intrusion point during a severe thunderstorm. Addressing these issues proactively, before storm season, is almost always less expensive than dealing with them as emergencies. To understand how seasonal changes affect roof durability and plan your vulnerability assessment timing, consider the specific weather patterns your facility faces throughout the year.

Secure Rooftop Equipment

Walk your roof and identify everything that could become a projectile or could be damaged during high winds. HVAC units, satellite dishes, pipe supports, ladder access points, and any temporary equipment that's been left on the roof all need to be evaluated.

Loose items need to be removed or properly secured. Equipment that's supposed to be anchored needs to be inspected to verify the anchors are still sound. This is particularly important in hail-prone areas like the DFW region where impact damage can weaken equipment mounting over time without obvious visible damage.

Clear Drainage Systems

Clogged drains and scuppers are one of the most common factors that turn normal rain into roof emergencies. When drains can't handle the water volume during intense storms, you get rapid ponding that stresses the roof structure and can find its way into the building through membrane seams or penetrations.

Clean all drains, check that drain strainers are in place and not damaged, verify that scuppers and overflow drains are clear, and make sure downspouts aren't blocked. If your facility has internal roof drains, consider having them professionally cleared with a drain snake to remove buildup that you can't see from the roof surface.

This maintenance should happen before storm season starts. In Texas and Oklahoma, that means late winter or early spring before the severe weather pattern begins in March and April.

Establish Your Emergency Contact List

Create a documented list of who needs to be contacted when roof damage occurs, in what order, and what information each party needs. This list should include:

Your pre-vetted emergency roofing contractor with 24/7 contact numbers. Don't wait until you need them to identify who this will be. Research contractors now, verify their emergency service capabilities, confirm they serve your area, and establish the relationship before the emergency happens. TriVAN Roofing provides 24/7 emergency roof repair services throughout Texas and Oklahoma and can be added to your emergency contact list as a pre-vetted resource.

Your insurance agent or carrier's claims number with your policy number readily available. Some carriers have specific emergency notification numbers that are different from your agent's office number. Verify what number you're supposed to call and what timeframe you have for notification.

Internal contacts including building security, operations managers, and anyone who needs to know about potential business disruption. Make sure you have both primary and backup contacts because emergencies don't always happen during business hours when your first-choice person is available.

Key building systems contacts if your facility has critical operations that could be affected by roof damage. If water intrusion could impact server rooms, production equipment, or sensitive inventory, the people responsible for those areas need to be in your notification chain.

Document Your Facility-Specific Decision Protocols

Create simple decision trees that guide response based on the type and severity of damage. These don't need to be complex, but they need to be written down so that anyone responding can follow them.

For example: If water is actively entering the building and threatening equipment or inventory → immediate response is to protect interior assets with tarps or by moving items → then contact emergency contractor for temporary roof protection → then document and notify insurance. Versus: If damage is discovered after the storm has passed and no immediate threat to interior → document thoroughly → contact contractor for assessment → file insurance claim within required timeframe.

Having these protocols documented prevents the decision paralysis that facility managers often experience when trying to figure out what to do first while water is actively coming in and multiple people are calling demanding action.

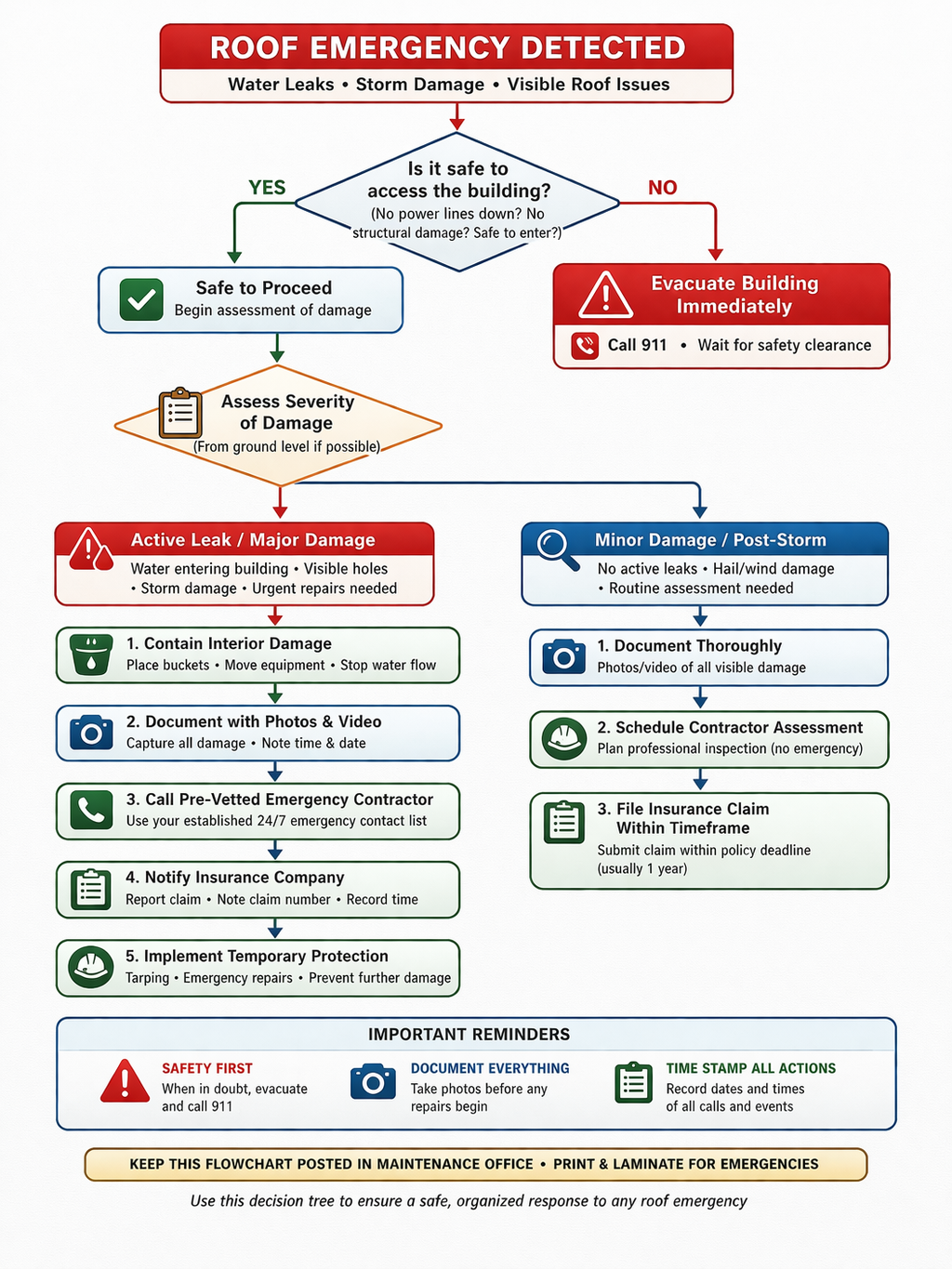

Immediate Response During Active Storms

When severe weather is actively hitting your facility, your priority is safety first, then positioning yourself to respond quickly once conditions allow.

Monitor Weather and Facility Conditions

If your facility operates 24/7, designate someone to monitor weather conditions and conduct periodic interior checks for any signs of water intrusion. For facilities that close at night, security or alarm monitoring should be instructed to look for water intrusion indicators, not just security threats.

Many facility managers don't learn about roof damage until hours after it occurs because no one was checking for it during or immediately after the storm. The faster you identify a problem, the faster you can contain the damage.

Safety Assessment Before Roof Access

Never access the roof during active weather or immediately after severe storms. Wait for winds to drop below 20 mph, avoid any roof access if lightning is still occurring in the area, and evaluate whether the roof surface might be damaged in ways that make it unsafe to walk on.

After major hail events, membrane surfaces can be compromised in ways that aren't immediately visible. After high wind events, you might have loose debris or damaged edge details that create fall hazards. When in doubt, wait for your professional contractor to make the initial assessment rather than risking injury to your staff.

Initial Interior Damage Control

If water is entering the building, your immediate priority is containing interior damage while you wait for contractor response. Move inventory or equipment away from leak areas if safe to do. Place collection containers to catch water and prevent it from spreading. Use tarps to protect equipment that can't be moved.

Document everything with time-stamped photos and video. Take pictures of the ceiling where water is entering, the accumulated water on the floor, and any affected equipment or inventory. This documentation is critical for insurance claims and for helping your contractor understand the scope and urgency when you contact them.

Contractor Selection and Vetting for Emergency Situations

One of the biggest challenges facility managers face after severe weather events is distinguishing between legitimate emergency contractors and storm-chasing operators who appear after every major weather event looking for quick money.

Red Flags for Storm-Chasing Contractors

After every major hail event or tornado in Texas and Oklahoma, trucks with out-of-state license plates start working neighborhoods and commercial areas offering immediate roof repairs. Many of these contractors are unlicensed, uninsured, or inexperienced with commercial roofing systems. They take deposits and either do substandard work or disappear entirely.

Warning signs include: contractors who show up unsolicited immediately after storms, demands for large upfront payments or cash-only arrangements, inability to provide local references from similar commercial projects, no physical business address or only a P.O. box, pressure to sign contracts immediately without time to review or get competing bids, and offers to waive your insurance deductible (which is insurance fraud and can jeopardiate your claim).

Storm chasers often have persuasive pitches. They'll show you photos of hail damage (that might not actually be from your roof), create urgency by claiming they can only lock in pricing if you sign immediately, and promise to handle everything with your insurance. Facility managers under pressure to get the building protected can make quick decisions they regret once these contractors fail to show up or deliver work that doesn't pass inspection.

The best protection is having your contractor already selected and vetted before the emergency happens. But if you're evaluating contractors during an active emergency, slow down enough to verify a few critical things even under time pressure.

What to Verify Before Signing Emergency Contracts

Ask for proof of licensing in Texas or Oklahoma. Commercial roofing contractors should be able to provide their license number immediately. You can verify it's current through the state licensing board website.

Request proof of insurance including general liability and workers compensation. Call the insurance company directly to verify the policy is active and covers the scope of work. Don't accept a certificate of insurance without verification because fraudulent certificates are common.

Ask for references from similar commercial projects completed in the last 12 months. Call those references and ask specifically about the contractor's emergency response time, quality of temporary protection, and whether permanent repairs were completed as promised.

Verify they have the equipment and crew capacity to respond to your facility. A residential roofing contractor might have emergency availability, but they might not have the equipment needed for large commercial flat roofs or the crew size to handle extensive tarping on a 50,000 square foot building.

Get written estimates before any work begins, even for emergency temporary repairs. The estimate should specify what temporary measures will be taken, what the cost will be, and what timeline you can expect for permanent repairs. Avoid contractors who want to start work immediately without providing any written documentation of scope and cost.

Working With Pre-Vetted Emergency Contractors

If you've established a relationship with a commercial roofing contractor before the emergency, the response process is much simpler. They already have your facility information, they understand your roof system, and you've already verified their qualifications and capabilities.

Many facility managers maintain informal relationships with their roofing contractors specifically for emergency situations even if they're not currently under a maintenance contract. A phone call every year or two to confirm the contractor still has emergency availability and to update your contact information keeps the relationship active without ongoing cost.

Some facility managers build emergency response into their maintenance agreements. The contractor agrees to prioritized emergency response for facilities under maintenance contracts. This approach ensures availability because you're a current customer rather than a new caller competing with dozens of other facilities for emergency service after a major storm.

Insurance Notification Requirements and Documentation

Commercial property insurance claims for roof damage have specific requirements that many facility managers don't know about until they're trying to file a claim. Missing these requirements or providing inadequate documentation can delay your claim or reduce your settlement.

Notification Timeframes

Most commercial property policies require notification of loss within a specific timeframe, typically 24-72 hours after damage occurs or after you discover the damage. These requirements are usually in the "Duties After Loss" section of your policy.

The clock starts when you discover the damage, not when the storm occurred. If your facility was closed during a weekend storm and you don't discover roof damage until Monday morning, you have 24-72 hours from Monday morning, not from when the storm actually hit.

Late notification can give the insurance carrier grounds to deny or reduce your claim, arguing that the delay prevented them from assessing the full extent of damage or that additional damage occurred because you didn't notify them promptly.

Required Documentation

Insurance adjusters need to see what damage was caused by the covered event versus what was pre-existing condition. This is why the pre-storm documentation you created is valuable. You can show the adjuster that damage visible now was not present during your last inspection.

When damage occurs, document everything thoroughly before any temporary repairs are done. Take wide shots showing the overall affected area, close-up photos of specific damage points, interior photos showing water intrusion and affected spaces, and photos of any damaged equipment or inventory.

Use time-stamped photos if possible. Most smartphones automatically embed date and time data in photo files. This timestamp proves when the damage was documented relative to the storm event.

Take video as well as photos. Video helps insurance adjusters understand the scope and context in ways that still photos alone don't capture. A 60-second video walking through a damaged area provides more information than 20 individual photos.

Temporary Repairs and Claim Impact

You have a duty to mitigate damage, which means you can't just leave your roof open to the weather while you wait for the insurance adjuster to inspect. You need to implement temporary protection to prevent additional damage.

Document the temporary repairs with photos before and after. Save receipts for all temporary repair costs including tarping, emergency contractor fees, and any equipment rental needed for the temporary protection.

Most policies cover reasonable temporary repair costs. The key word is reasonable. A professional roofing contractor's emergency tarping and temporary waterproofing is reasonable. Trying to handle it yourself with hardware store tarps in a way that causes additional damage is not.

Avoid making permanent repairs before the insurance adjuster has inspected and documented the damage unless you get explicit authorization from your insurance carrier. If you replace damaged membrane before the adjuster can verify what was damaged, you might have difficulty proving the extent of loss.

Working With Adjusters

Insurance adjusters who specialize in commercial property are generally professional and fair, but they work for the insurance company, not for you. Their job is to assess damage accurately but also to protect the carrier from overpayment.

Be present during the adjuster's inspection if possible. Walk the roof with them and point out all damaged areas. Adjusters are thorough, but they're also handling multiple claims after major storm events and can miss damage points.

Have your contractor present during the inspection if possible. A professional roofing contractor can identify damage that might not be obvious to someone who doesn't work with commercial roofing systems daily. Many types of membrane damage or fastener failures require specialized knowledge to recognize.

If you disagree with the adjuster's assessment, you have the right to request a re-inspection or to hire your own independent adjuster. Most policies have provisions for handling disputes between the insured and the carrier. Don't assume the first assessment is final if you have legitimate reasons to believe damage was underestimated.

Temporary Protection Methods and Permanent Repair Decisions

Once you've notified insurance and have a contractor responding, the immediate priority is implementing temporary protection that will keep weather out of your building until permanent repairs can be completed.

Emergency Tarping and Temporary Waterproofing

Professional emergency tarping uses heavy-duty reinforced tarps that are properly secured with adequate overlap and anchoring. The goal is to create a weather-tight barrier that will hold up for weeks or potentially months if permanent repair schedules are delayed.

Poor tarping is sometimes worse than no tarping. If tarps aren't properly anchored, they can tear loose during subsequent wind events and cause additional damage. If they're not overlapped correctly, water can infiltrate under the tarps and you still have leaks. If they're secured in ways that penetrate the roof membrane, you're creating new leak points.

This is why emergency tarping should be handled by professional commercial roofing contractors with the right equipment and experience. Facility maintenance staff with hardware store tarps and rope rarely achieve adequate temporary protection on large commercial roofs.

For some types of damage, temporary waterproofing products can be more effective than tarps. Liquid-applied membranes or tape systems can seal specific damage points without requiring full tarping of large areas. Your contractor should assess what temporary protection method is most appropriate for your specific damage pattern.

Assessing Repair Versus Replacement

Once the immediate emergency is contained, you need to make decisions about permanent repairs. Small localized damage can usually be repaired without full roof replacement. Extensive damage might require replacing entire roof sections or the entire roof system.

Your contractor's assessment should address whether repair is technically feasible, whether repaired areas will perform adequately for the remainder of the roof's expected service life, and whether the cost of extensive repairs approaches the cost of replacement enough that replacement makes more sense.

Insurance will typically cover the lower cost option between repair and replacement unless damage is so extensive that replacement is the only viable option. But you're not required to take the cheapest option if you choose to upgrade. You can apply the insurance settlement toward a better system and pay the difference.

Consider the age and condition of your entire roof, not just the damaged area. If your roof is already 15-20 years old and you're facing major repair costs from storm damage, replacement might be the better long-term decision even if repair is technically possible. You avoid putting major money into a roof system that's approaching the end of its service life anyway.

Coordinating Permanent Repairs With Operations

Major roof repairs or replacement on occupied buildings requires coordination with your operations to minimize business disruption. Discuss scheduling options with your contractor - can work be done in phases, can it be done during off-hours or weekends, what areas of the facility will be affected and for how long.

For facilities that operate 24/7, phased work that keeps most of the building operational while work proceeds in sections might be the only viable approach. This extends the project timeline but maintains business continuity.

For facilities that can accommodate brief shutdowns, concentrated work over a long weekend or planned shutdown period minimizes total disruption even though intensity is higher during the work period.

Be realistic about noise, access, and temporary limitations. Roofing work is loud and involves equipment on the roof and vehicles around the building. Plan for these impacts rather than being surprised by them when work starts.

Regional Considerations for Texas and Oklahoma

Emergency planning needs to account for the specific weather patterns and risks your facility faces based on location.

DFW Region Storm Patterns

The Dallas-Fort Worth area experiences frequent severe thunderstorms from March through October with peak hail season in April and May. Hail events can be highly localized, with golf-ball sized hail destroying roofs in one area while locations five miles away see no damage at all.

The DFW region also sees occasional tornado activity and straight-line winds that can exceed 70 mph during severe thunderstorms. Facilities with older roof systems or roof-mounted equipment face higher risk during these events.

Winter weather in DFW is less predictable but can include ice storms that load roofs with weight and freeze-thaw cycles that can damage membrane seams. Facility managers need emergency plans that cover both severe spring/summer weather and occasional winter events. DFW storm patterns and hail frequency require specific emergency preparedness strategies for facilities in the North Texas region.

Oklahoma City and Tornado Alley

Oklahoma City sits squarely in Tornado Alley and experiences some of the most intense severe weather in the United States. Tornado season runs from March through June with May being the peak month. Facilities in the OKC area face not just tornado risk but the severe thunderstorms that produce tornadoes, including giant hail and extreme straight-line winds.

Oklahoma City tornado season preparedness should include shelter protocols for staff safety in addition to facility protection measures. When tornado warnings are issued, facility staff need to know where to shelter rather than attempting to assess or protect the building during the storm.

The frequency and intensity of Oklahoma severe weather means facility managers should assume they'll face roof damage at some point and plan accordingly rather than treating it as an unlikely event.

Tulsa and Northeast Oklahoma

Tulsa experiences similar severe weather patterns to Oklahoma City but with slightly different timing and intensity. The Tulsa area also faces winter ice storm risk that DFW and OKC see less frequently.

Ice accumulation on roofs creates both immediate load concerns and longer-term damage as ice melts and refreezes in membrane seams and flashing details. Facilities with older flat roofs that aren't designed for significant snow or ice load need to monitor winter weather forecasts and have snow removal contractors identified if heavy ice is predicted.

Long-Term Emergency Prevention Through Maintenance

The most effective emergency response plan is one you rarely need to use because you're preventing emergencies through proactive maintenance. Many of the maintenance mistakes that make roofs vulnerable to storm damage are preventable through regular inspections and minor repairs.

Preventive maintenance programs reduce emergency situations by identifying and addressing small problems before weather events turn them into major damage. A small membrane repair that costs $500 during routine maintenance becomes a $5,000 emergency repair after storm water has been entering the building through that vulnerability for hours.

Facility managers who track maintenance and emergency repair costs over time typically find that the ROI of proactive maintenance versus emergency repairs is compelling. The annual cost of routine maintenance and minor repairs is usually far less than the cost of two or three emergency responses plus the interior damage and business disruption that emergency situations create.

Conclusion

Building a commercial roof emergency response plan before you need it transforms how your facility handles severe weather events. Instead of scrambling to figure out who to call and what to do while water is actively damaging your building, you're executing a predetermined plan with pre-vetted resources and documented protocols.

The plan doesn't need to be complex. A vulnerability assessment, secured rooftop equipment, clear drainage, pre-vetted contractor relationships, documented insurance requirements, and written decision protocols cover the essential elements. What matters is having it documented and accessible so anyone on your team can execute the response even at 2 AM when you're not available.

Texas and Oklahoma facility managers face severe weather regularly enough that emergency planning isn't optional, it's just a question of whether you do it proactively or reactively. The difference between those two approaches is measured in thousands of dollars of interior damage, days of business disruption, and the stress of managing a crisis versus managing a planned response.

Tags: roof emergency plan, storm damage response, commercial roof leak, emergency roof repair, severe weather preparedness, hail damage protocol, facility emergency planning, storm preparation checklist, temporary roof protection
